From Vision to Reality: Delivering a DVSA-Compliant Class 7 MOT Facility

When AL Engineering set out to create a purpose-built Class 7 MOT testing facility, they knew the end goal but needed guidance for the steps in between. They required a turnkey solution, from planning and design through installation to DVSA approval.

This was more than a construction project; it would involve planning consent, specialist design, regulatory compliance, and DVSA approval. NextGen Workshop’s project management support ensured smooth progress from the initial enquiry through DVSA sign-off to operational success.

Identifying the Requirement

The brief was ambitious yet complex. AL Engineering needed a 60ft x 40ft building to accommodate HGV and Class 7 MOT testing, including an integrated MOT pit and all essential infrastructure. Success required professional oversight, technical coordination, and careful planning to turn the concept into reality, not merely the supply of a building and workshop equipment.

Impressed by our results for another customer, they chose us for the same standard. We launched the project with an on-site assessment to confirm costs and plans for a new two-bay building, inspection pit groundwork, and a full workshop fit-out. Coordinating closely with their planning advisor, we ensured compliance with local authority and DVSA rules to eliminate risks and delays.

Early Planning and Surveying

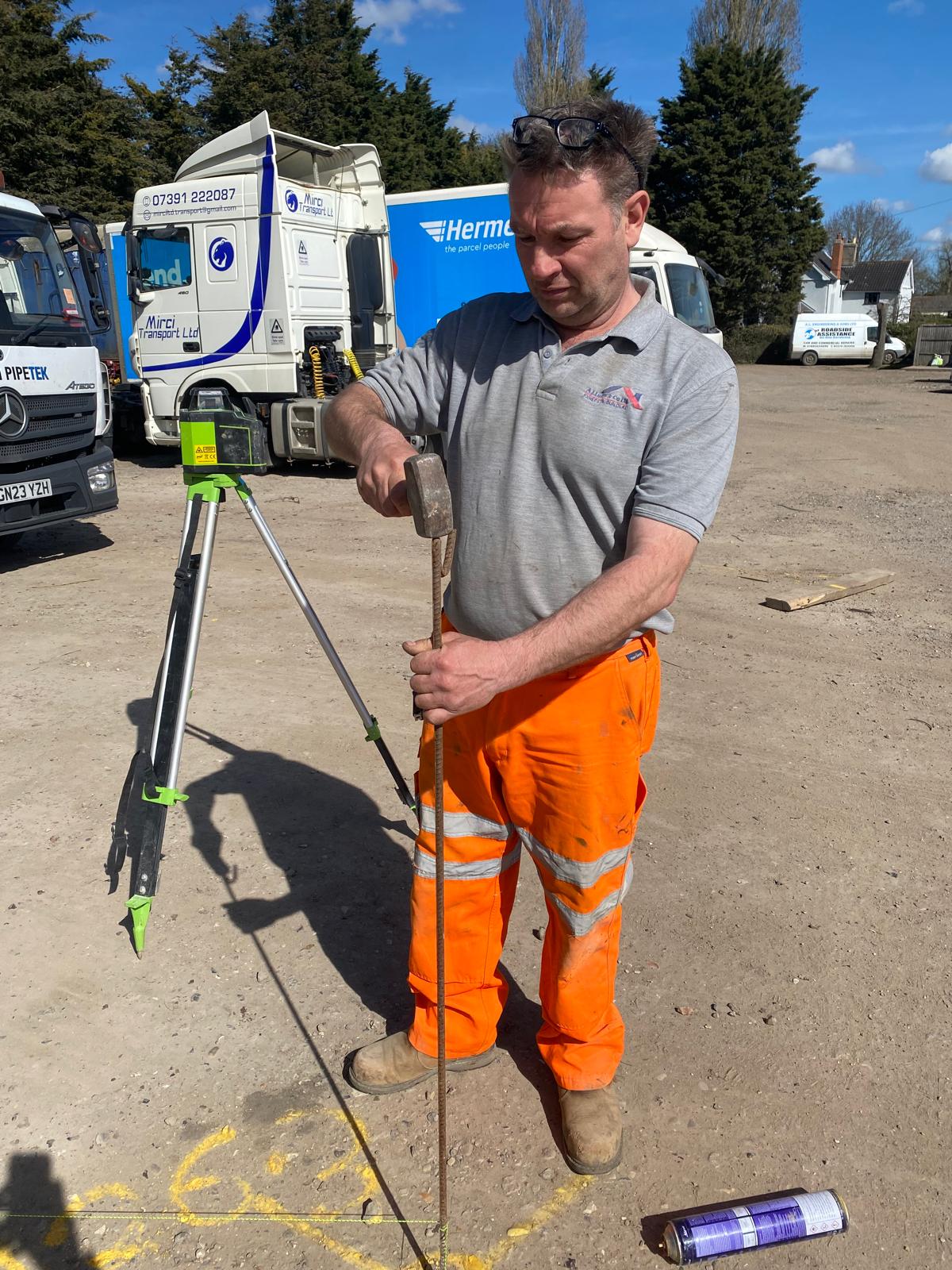

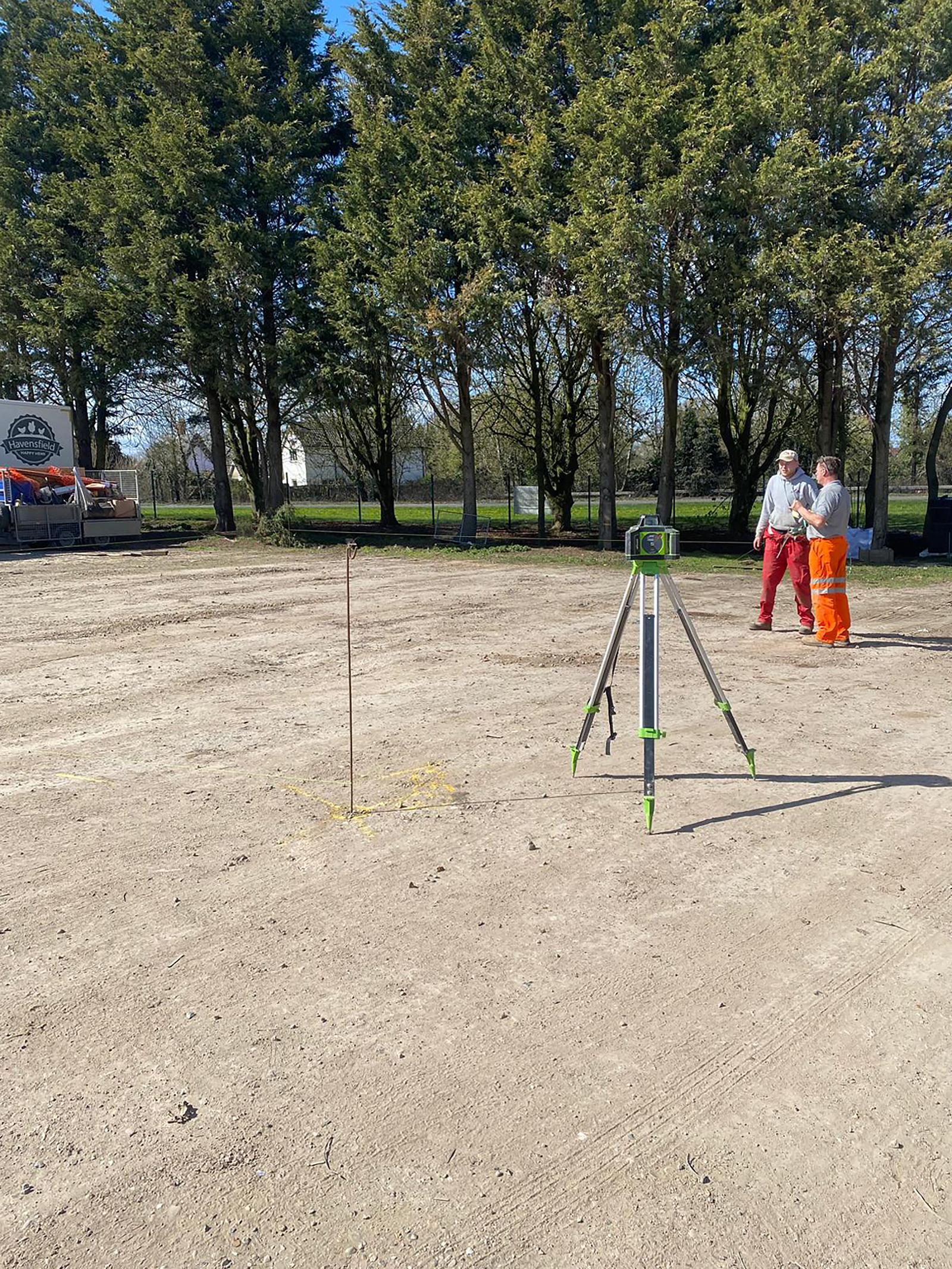

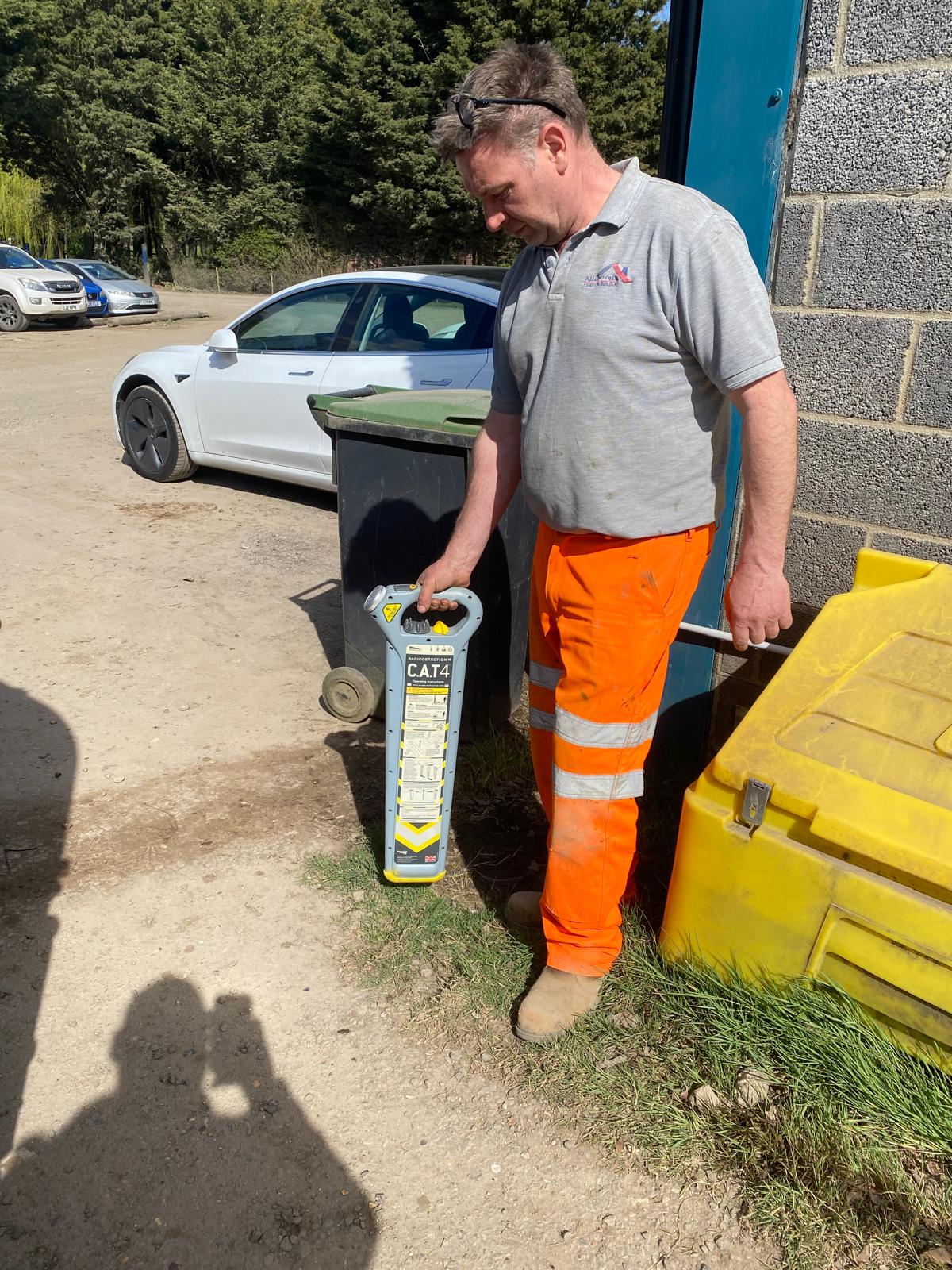

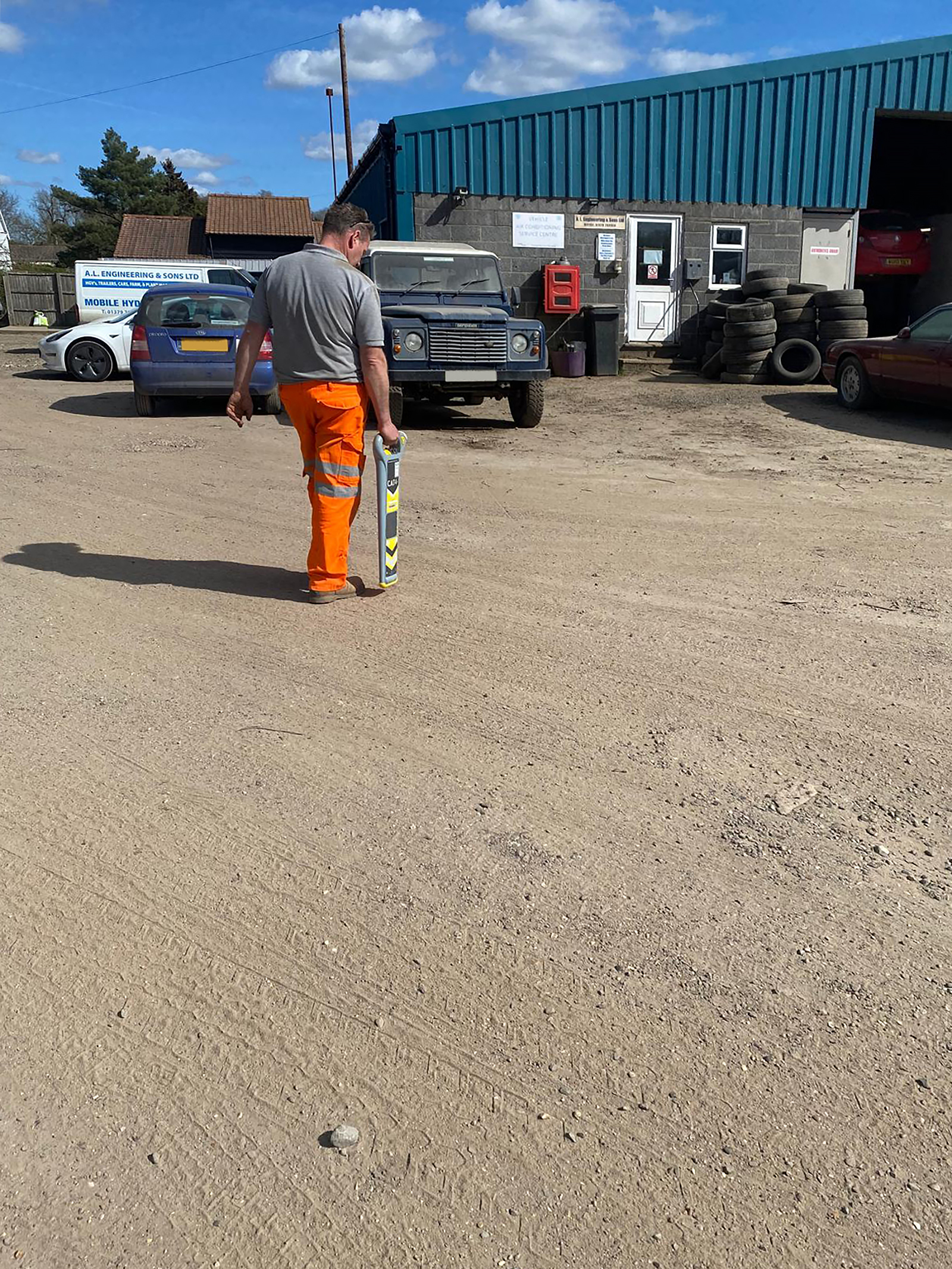

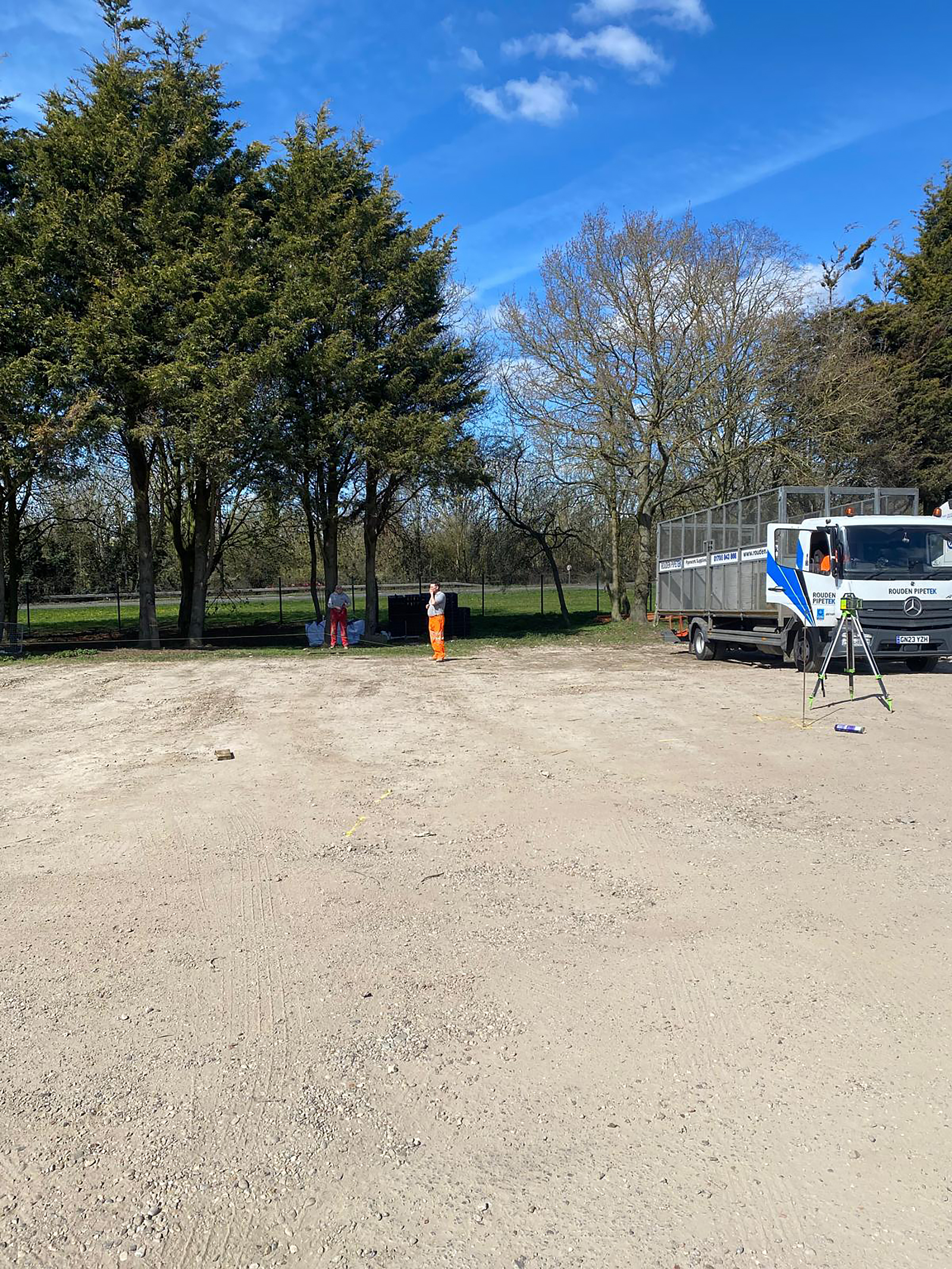

NextGen Workshops first became involved in the project in October 2023, at its earliest stage, before managing the process for AL Engineering. We coordinated site surveys, bringing in specialists to assess groundworks, slab design, pit installation, and CAD layout. These surveys ensured estimates were accurate and plans aligned with operational and regulatory needs.

We also assisted in navigating local authority requirements, including managing flood risk assessments, noise evaluations, and environmental surveys. These assessments introduced significant planning hurdles, but our proactive approach ensured responses and design adjustments were handled efficiently. At one point, the building’s location was slightly revised in response to flood report findings to maintain compliance without compromising functionality.

Procurement and Pre-Start Coordination

Meticulous planning won planning permission in June 2024, clearing the way for delivery. With permission secured, we shifted to execution. Between July 2024 and March 2025, we drove procurement, finalised specs and colours. We also commissioned detailed CAD drawings for the structure and MOT pit.

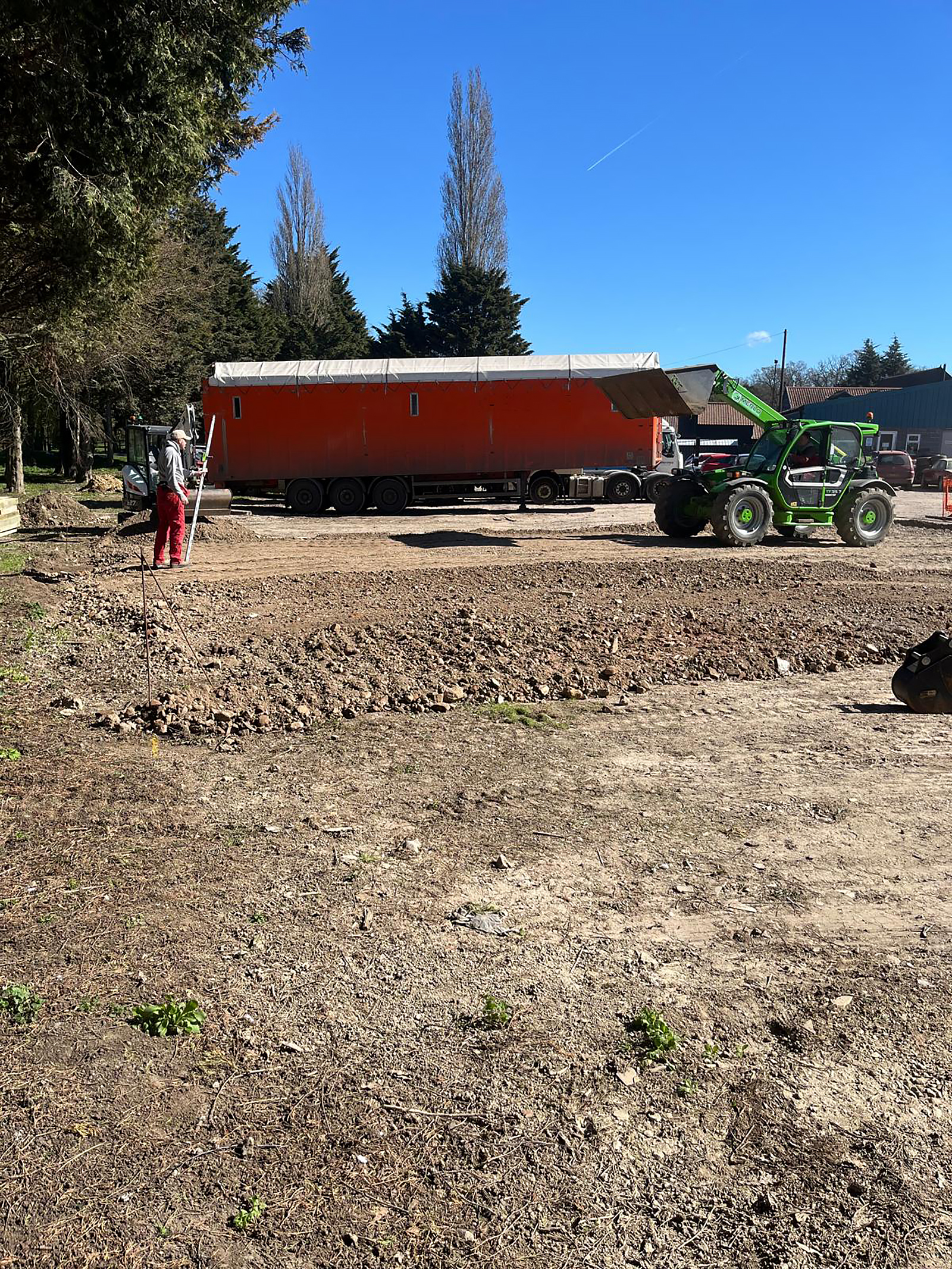

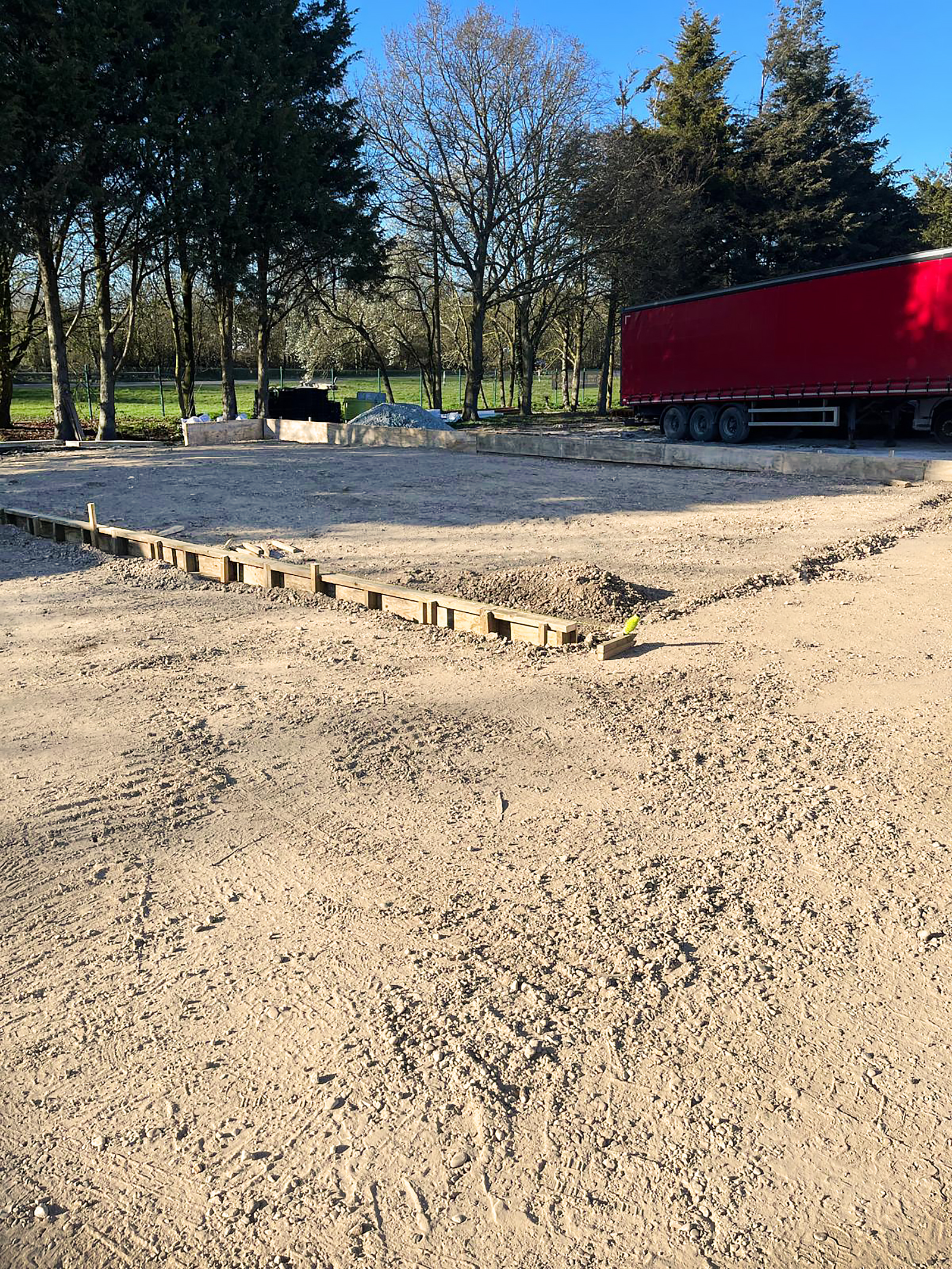

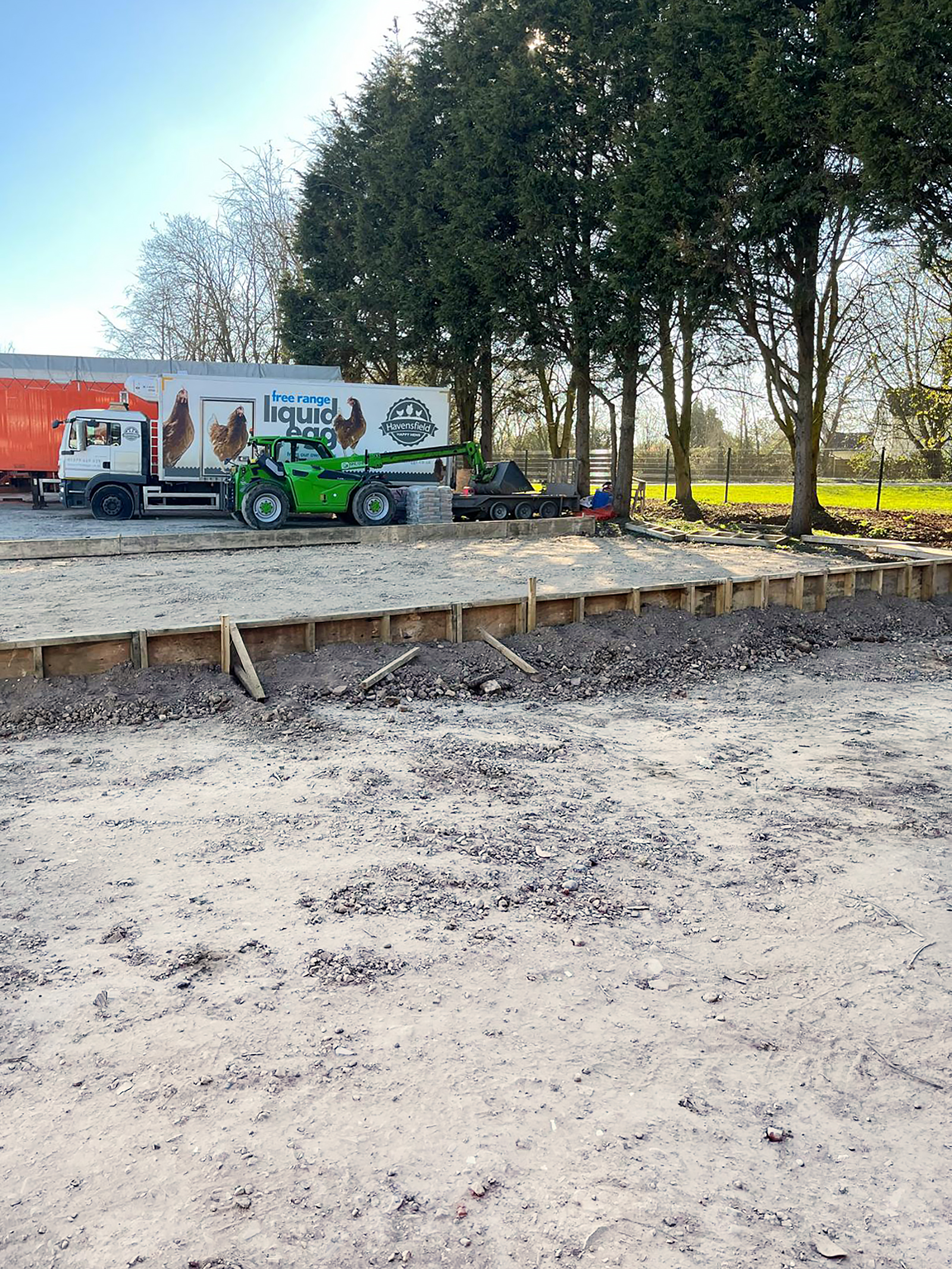

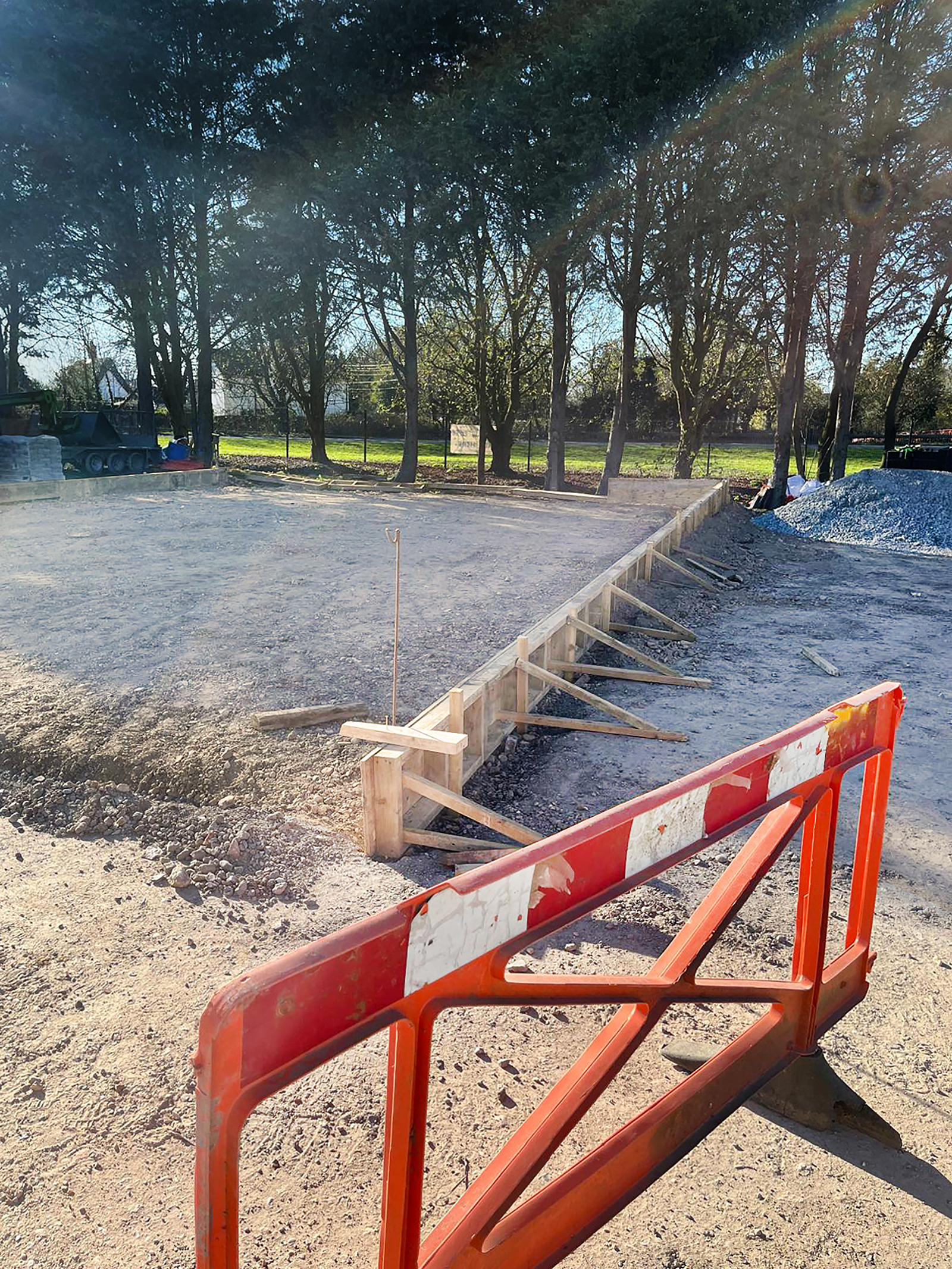

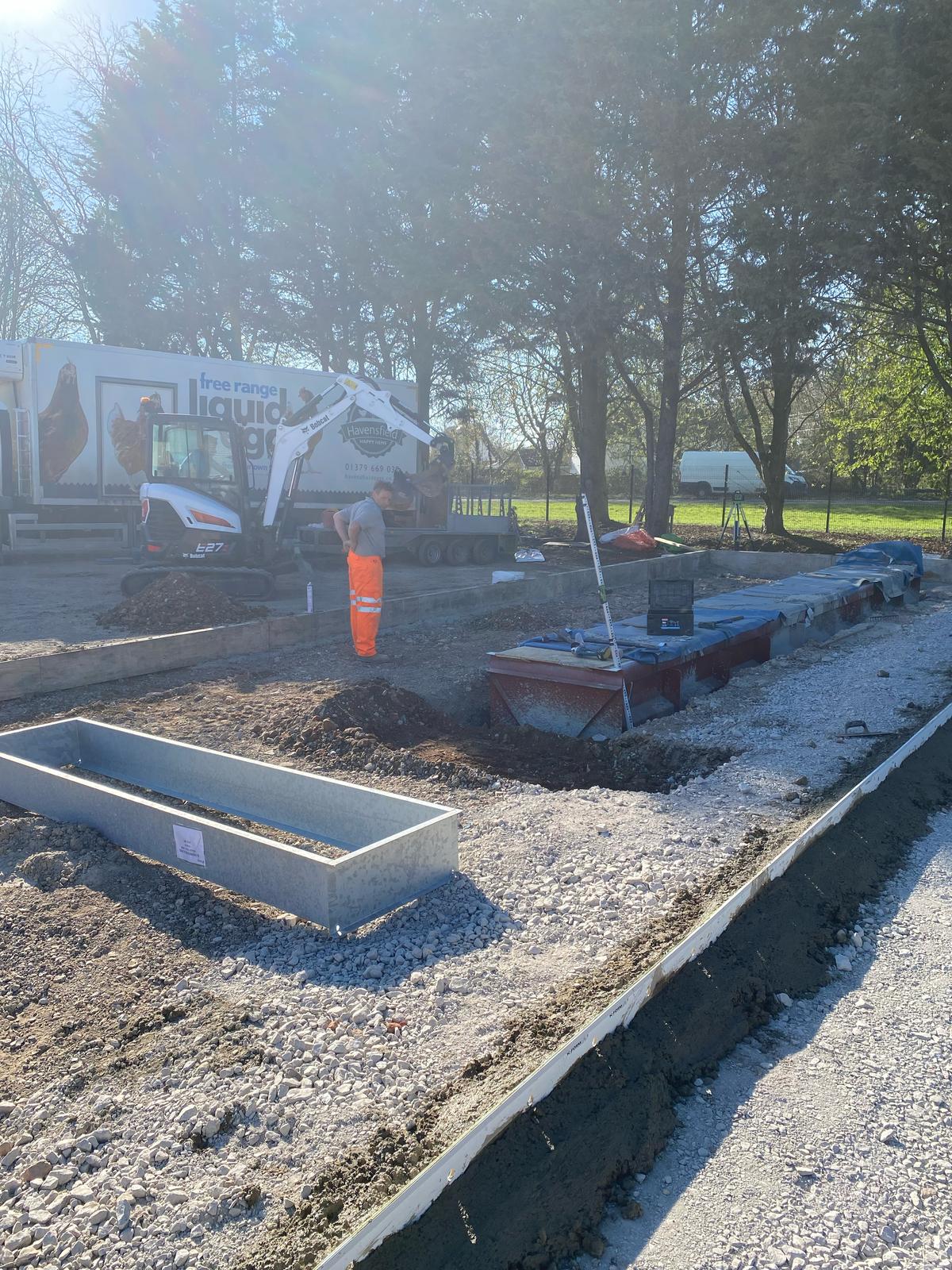

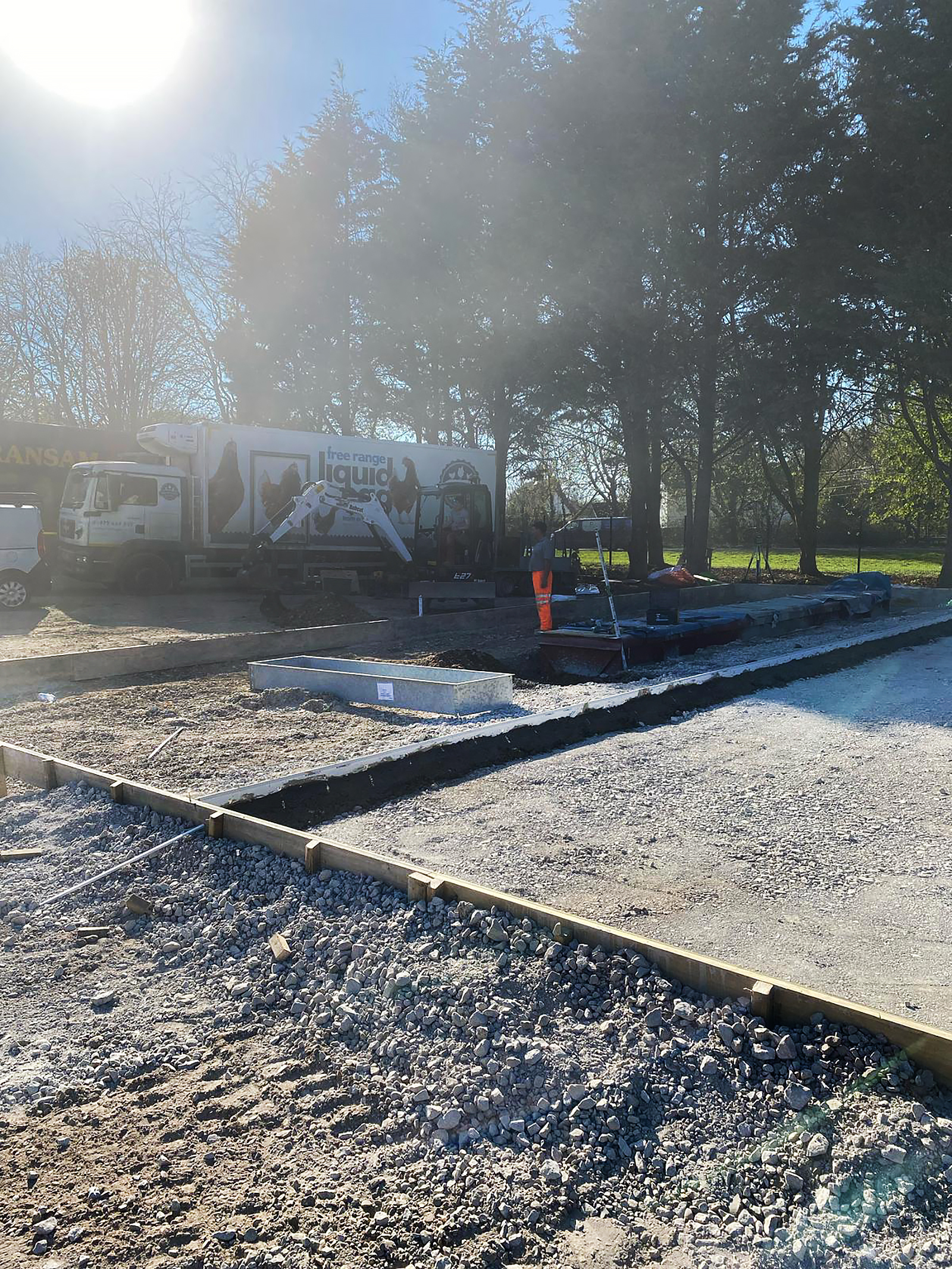

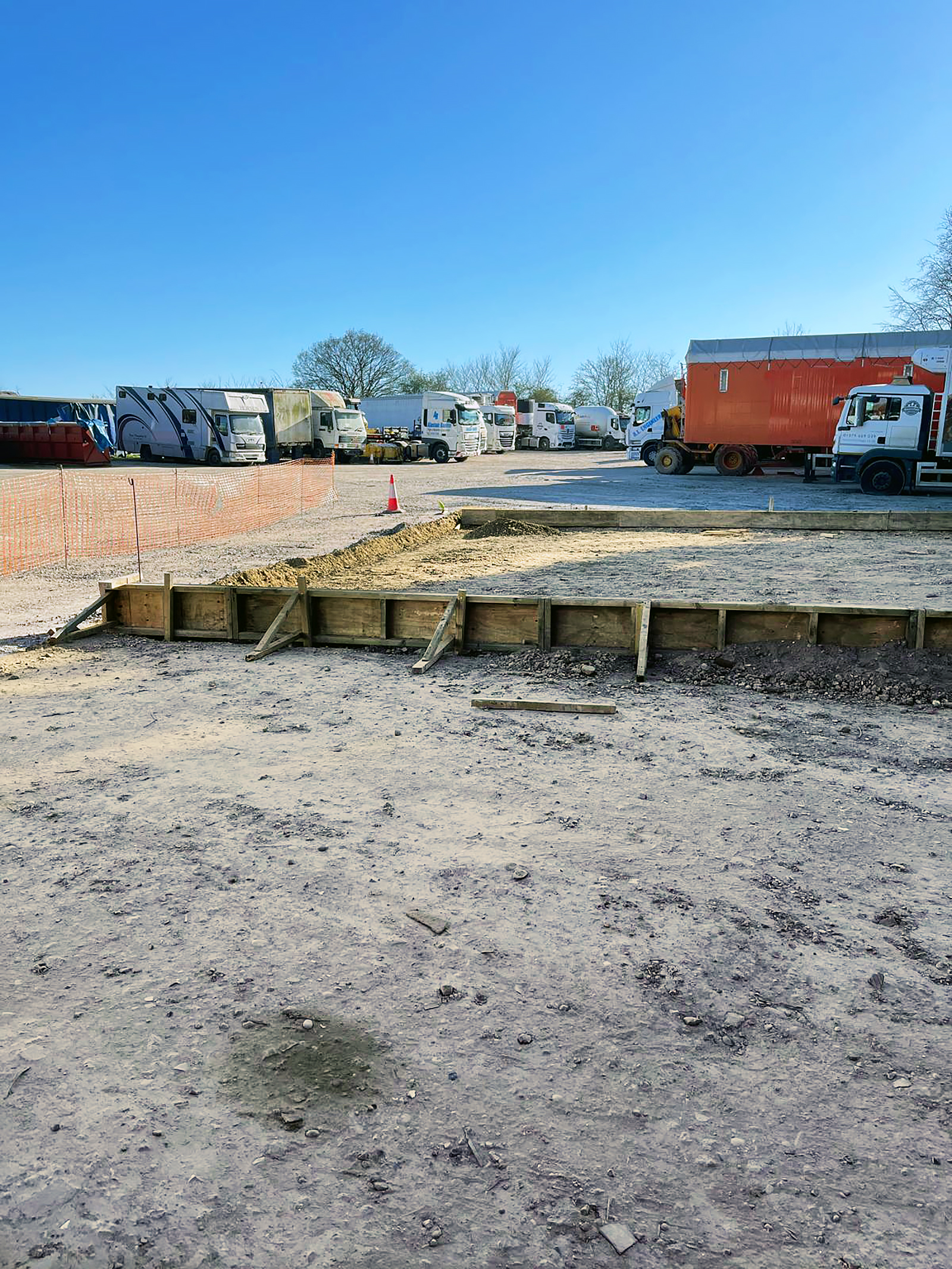

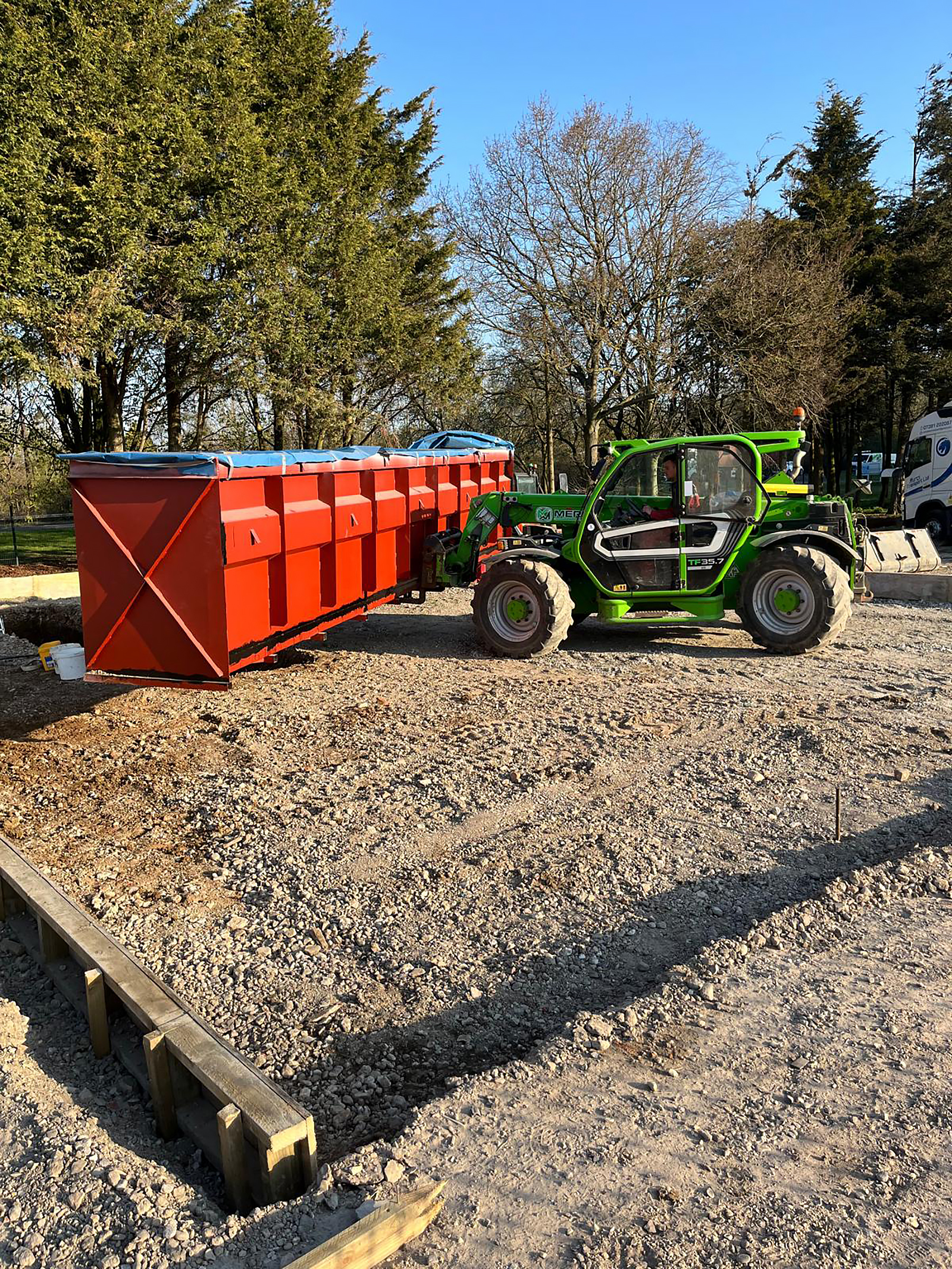

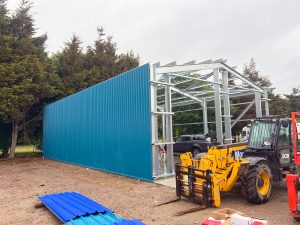

Orders for the building structure and pit were placed at the right time. Pre-commencement meetings ensured all subcontractors were aligned, with drawings reviewed together and sequencing confirmed before physical work began. Groundworks crews began “pegging out” the site at the end of March 2025, marking the end of planning and the start of execution.

Construction, Installation and Coordination

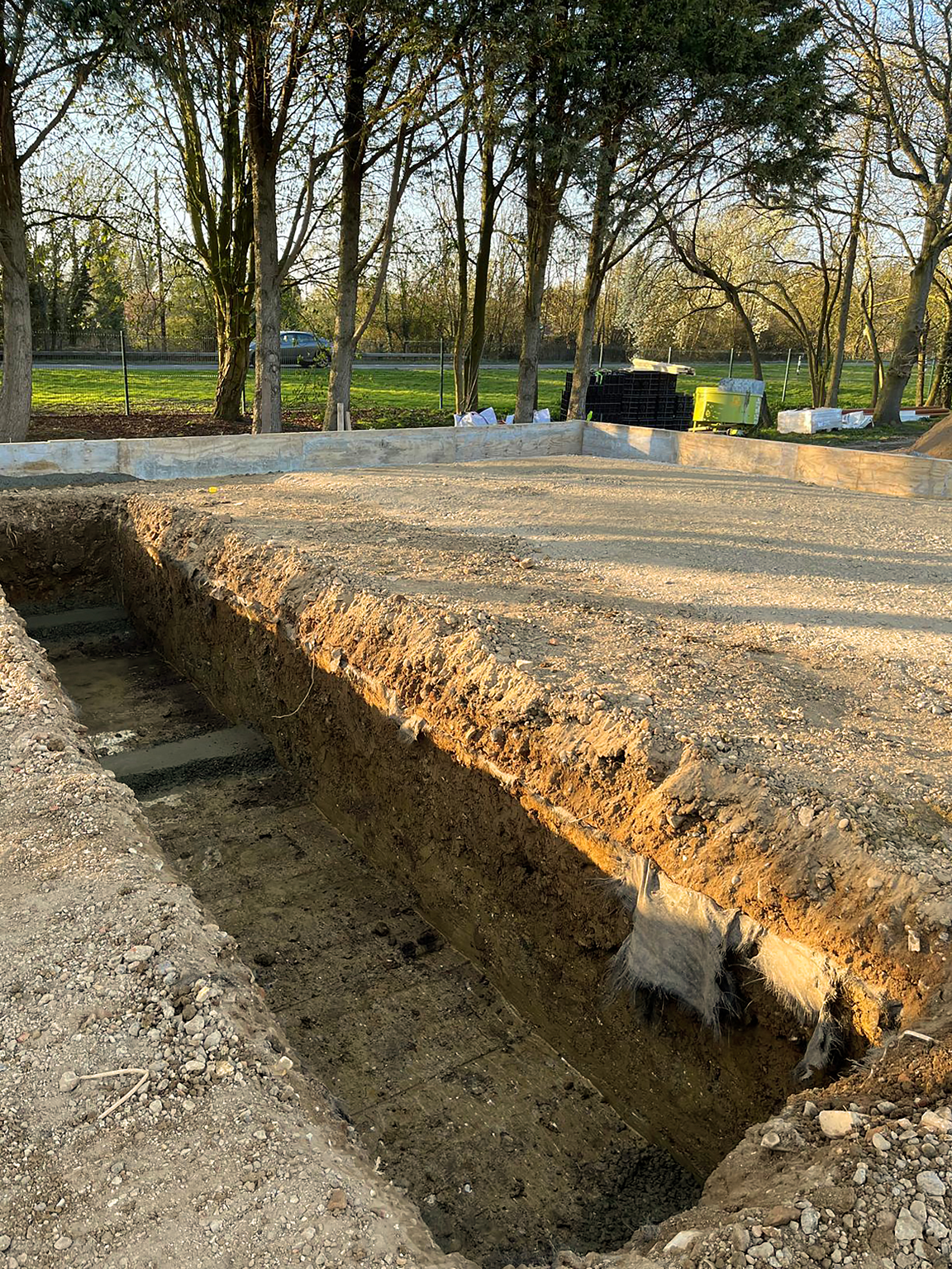

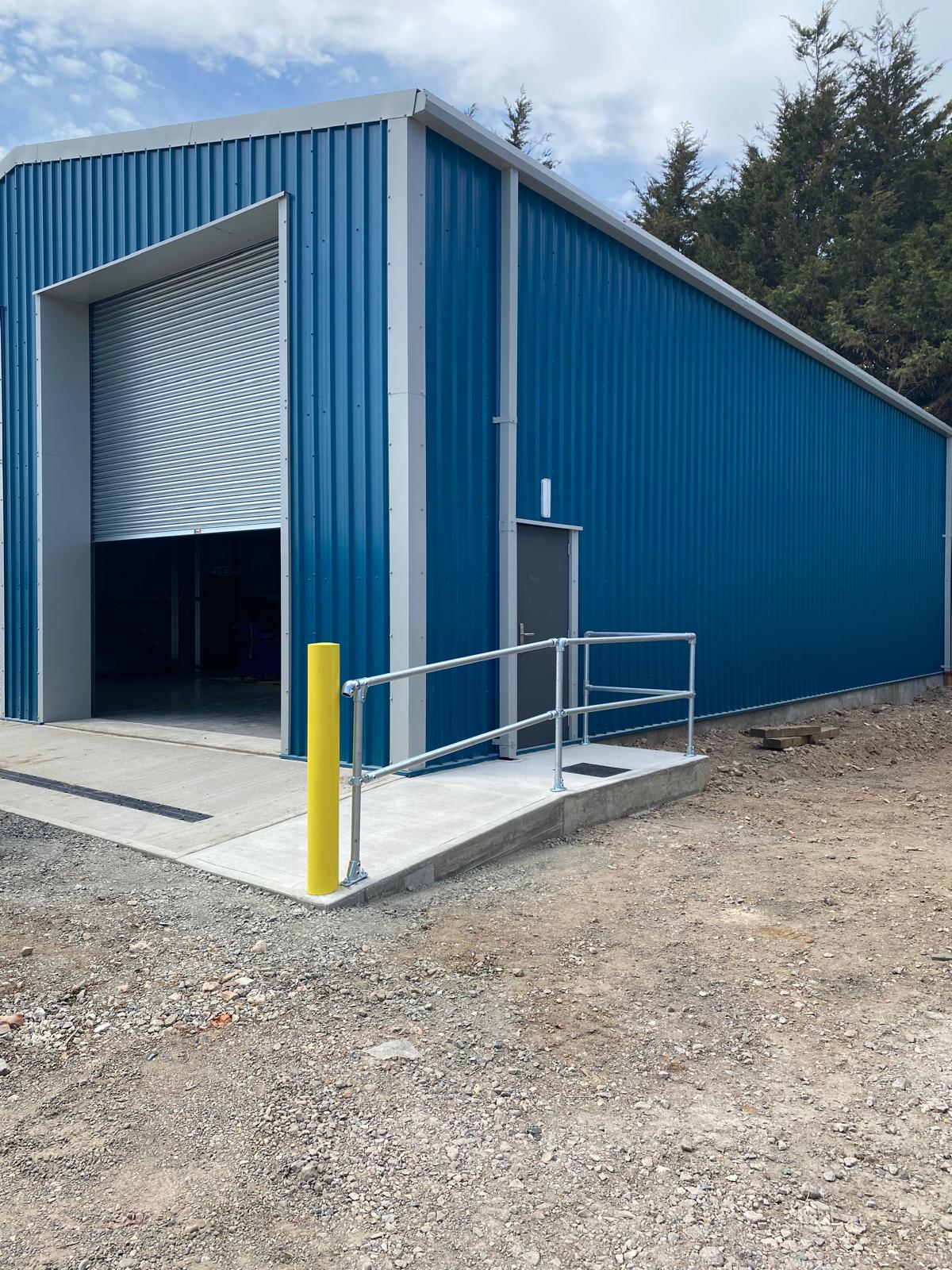

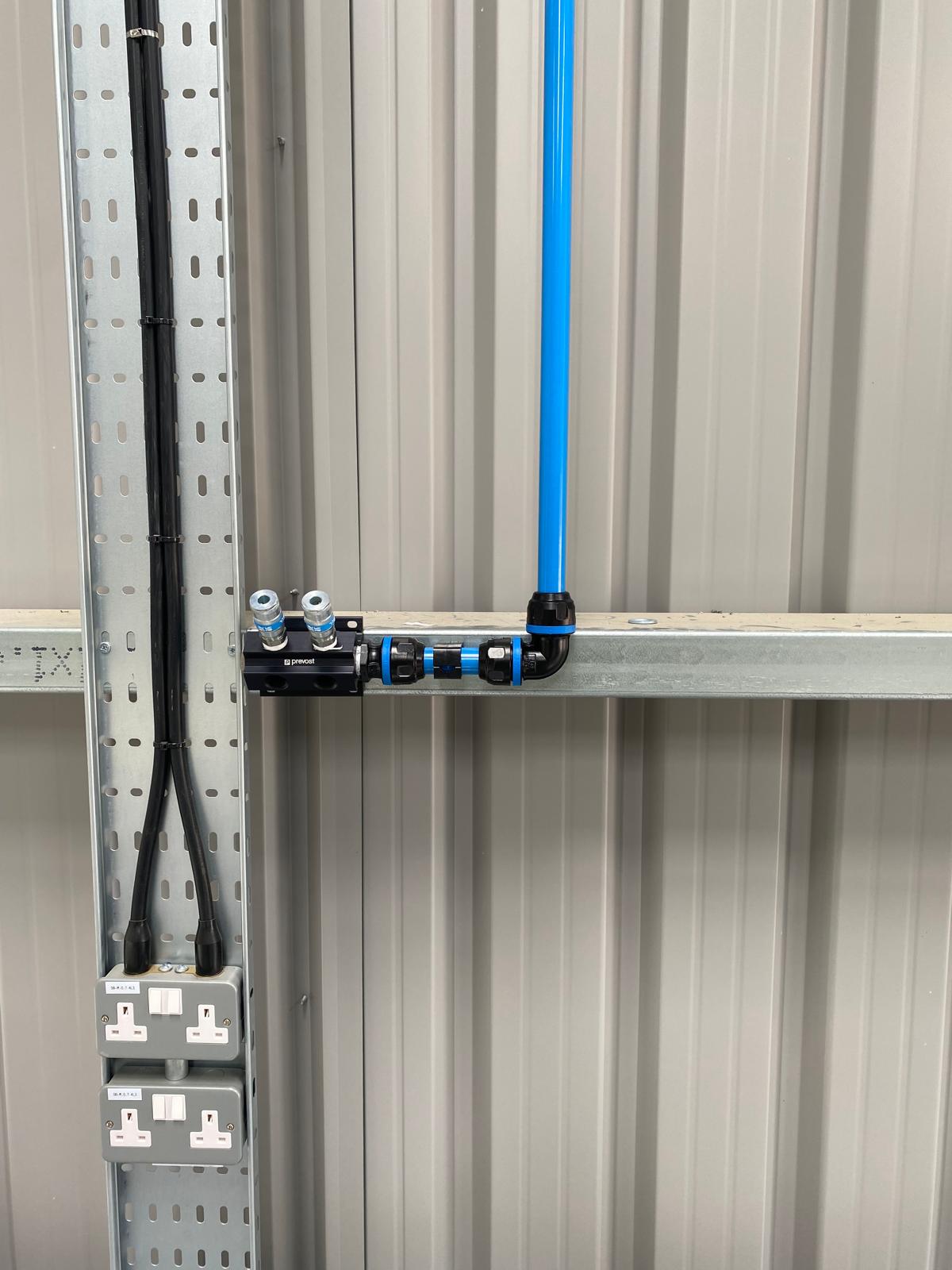

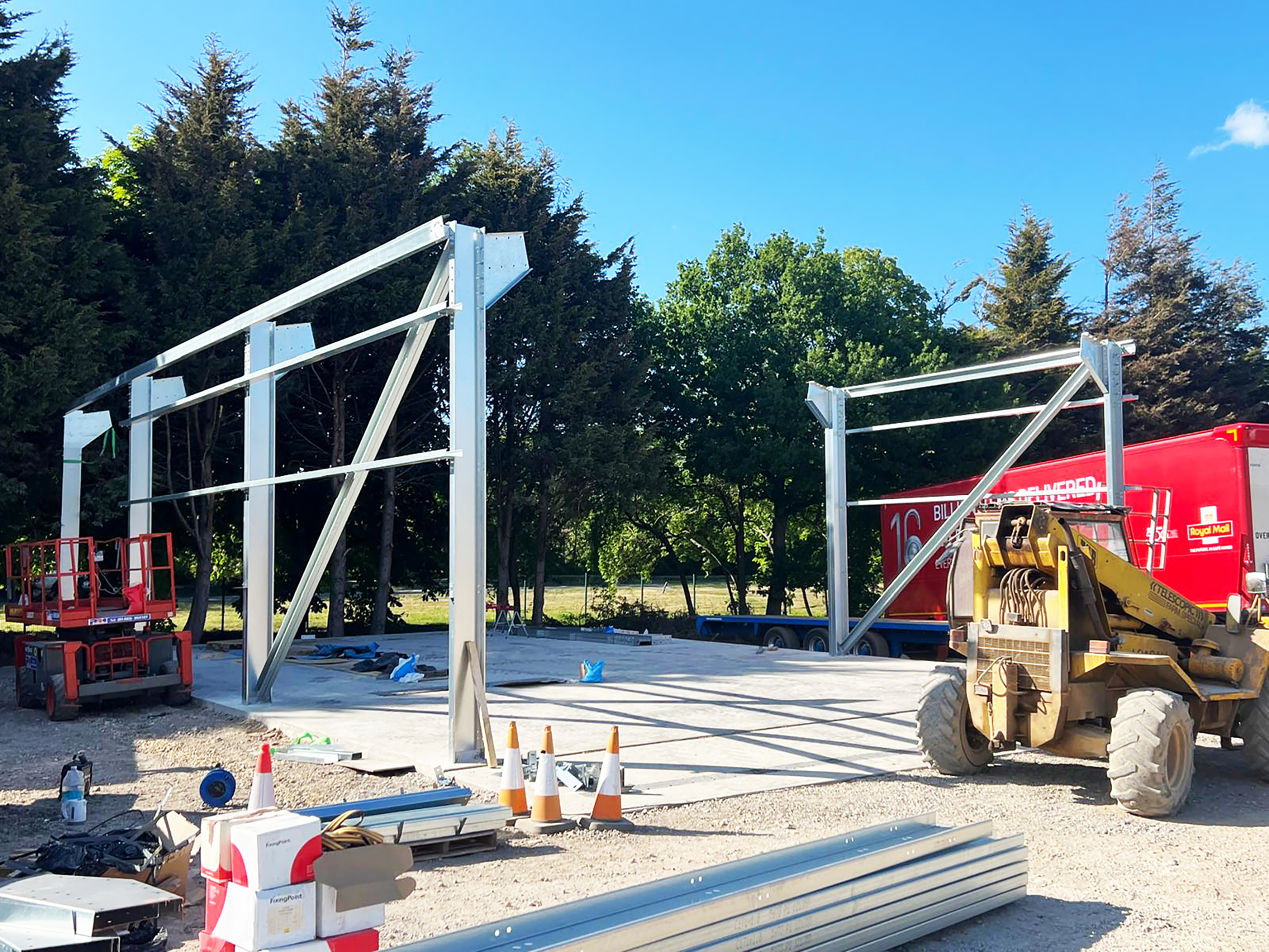

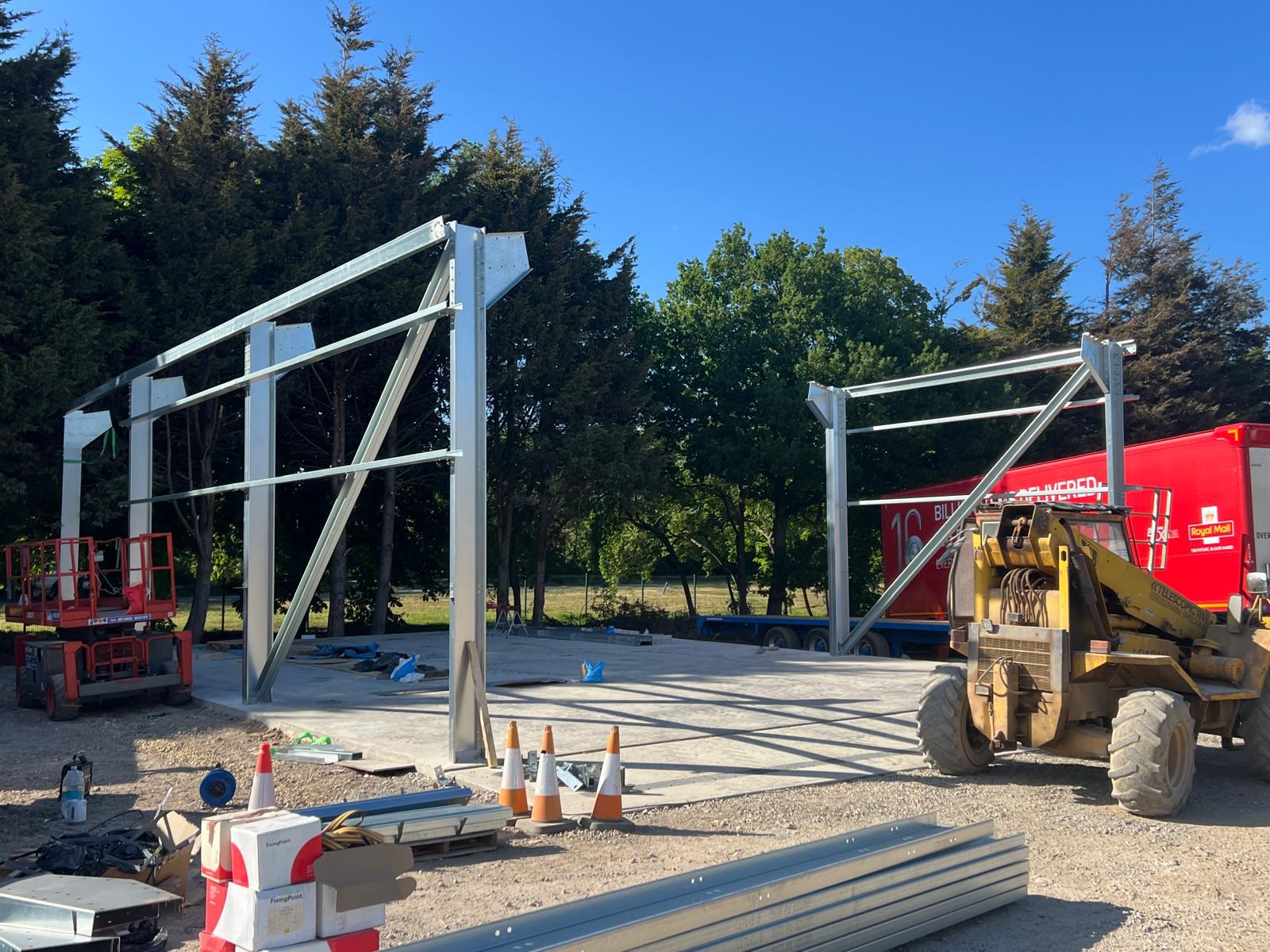

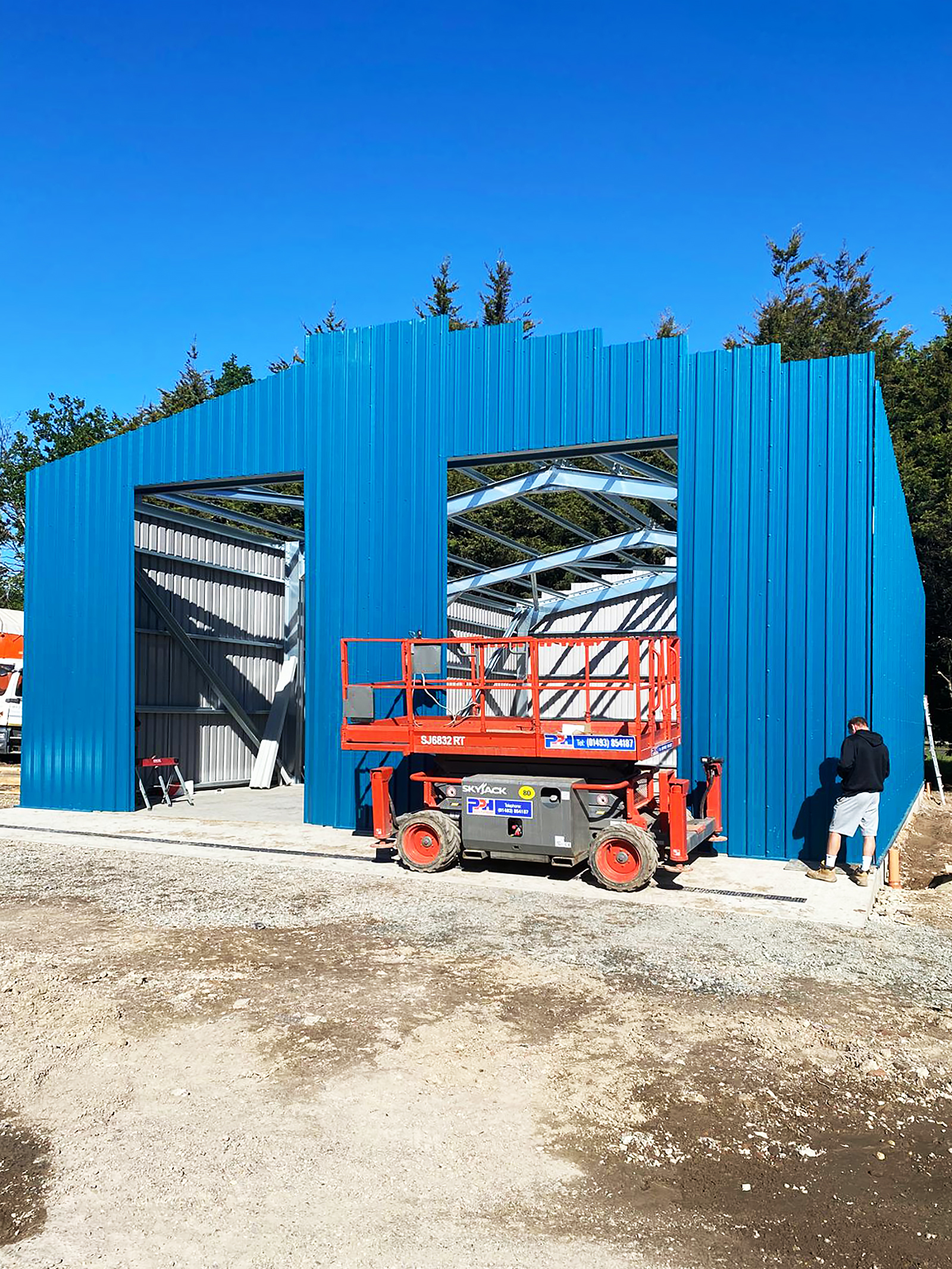

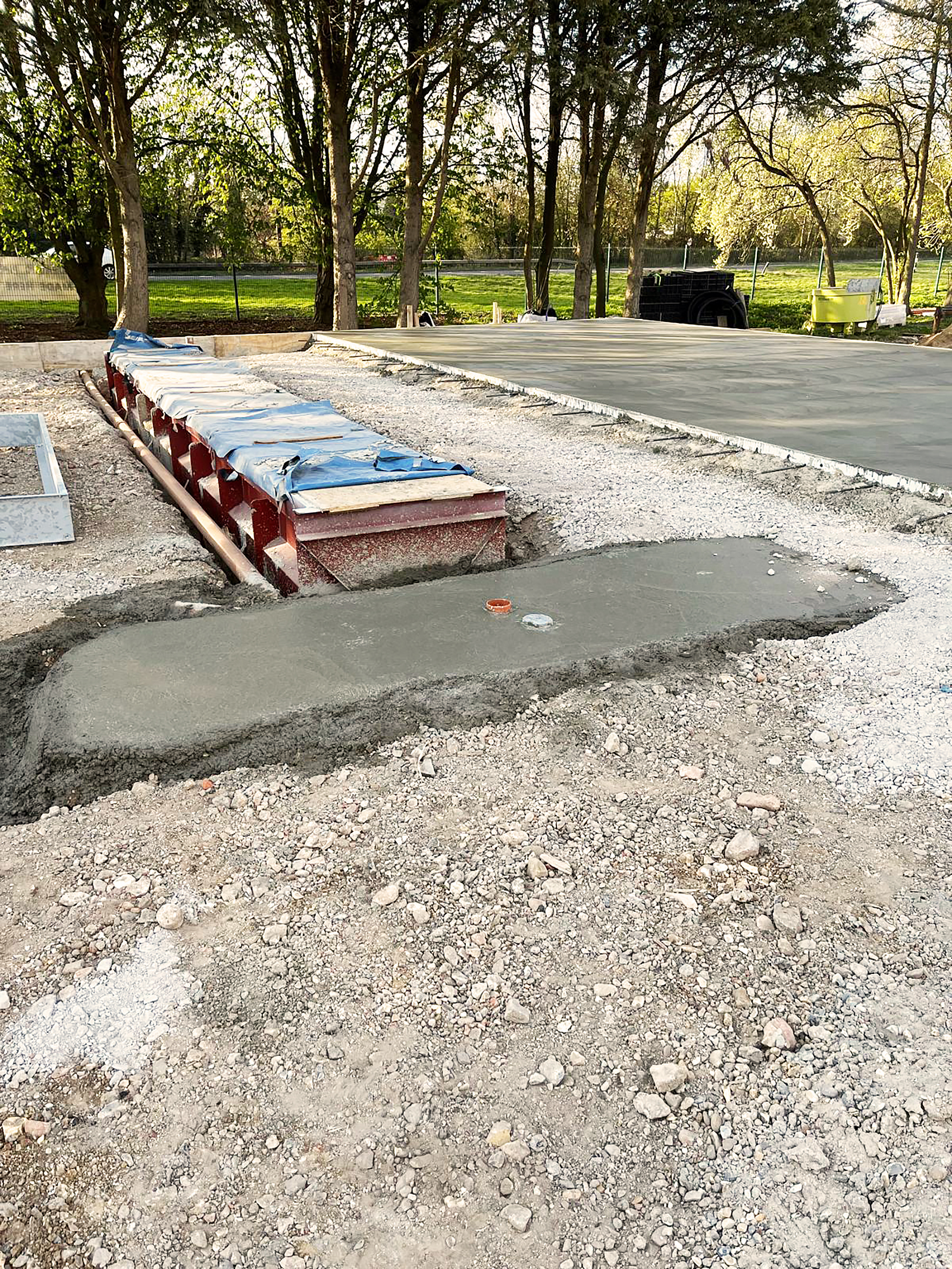

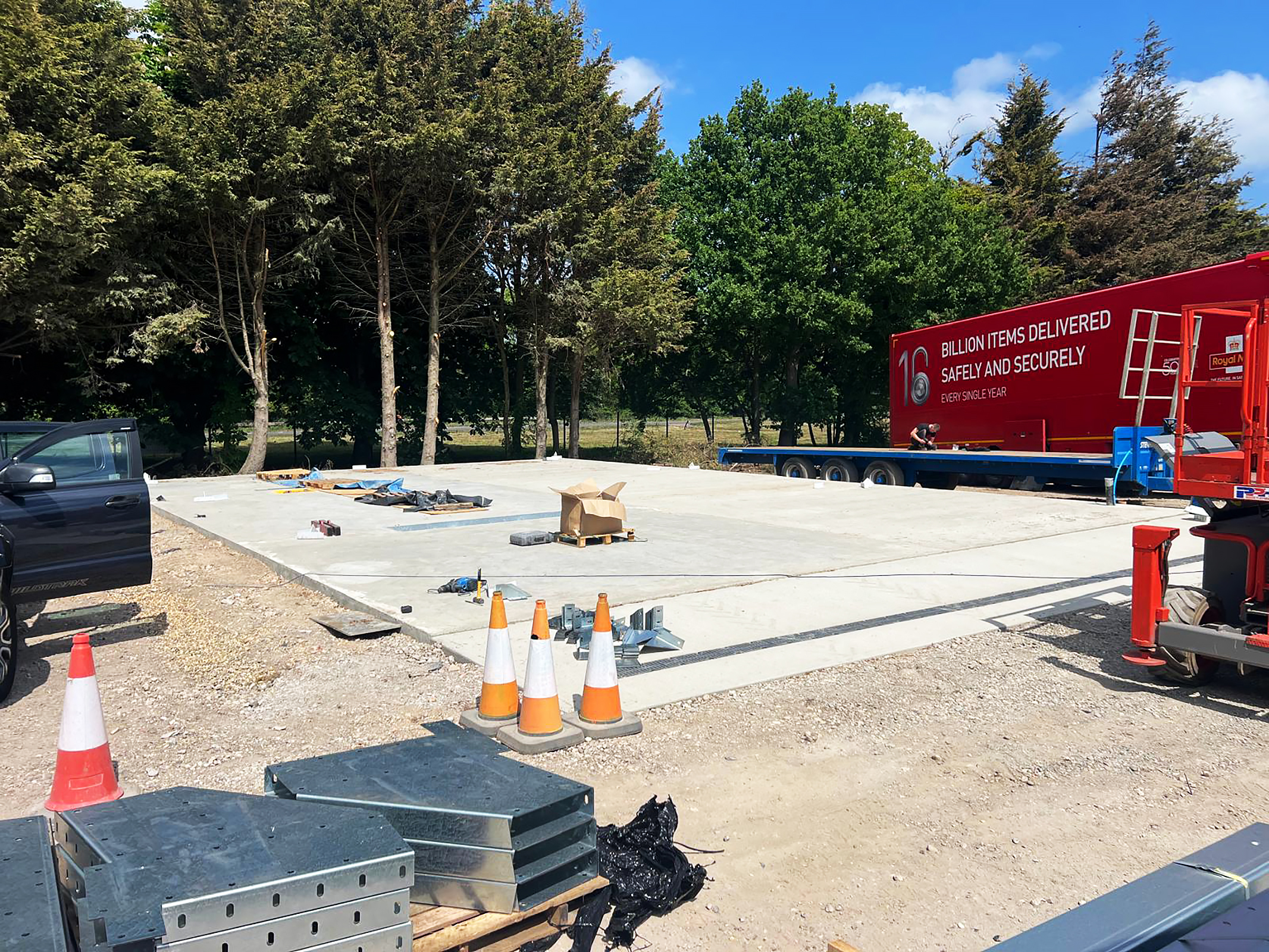

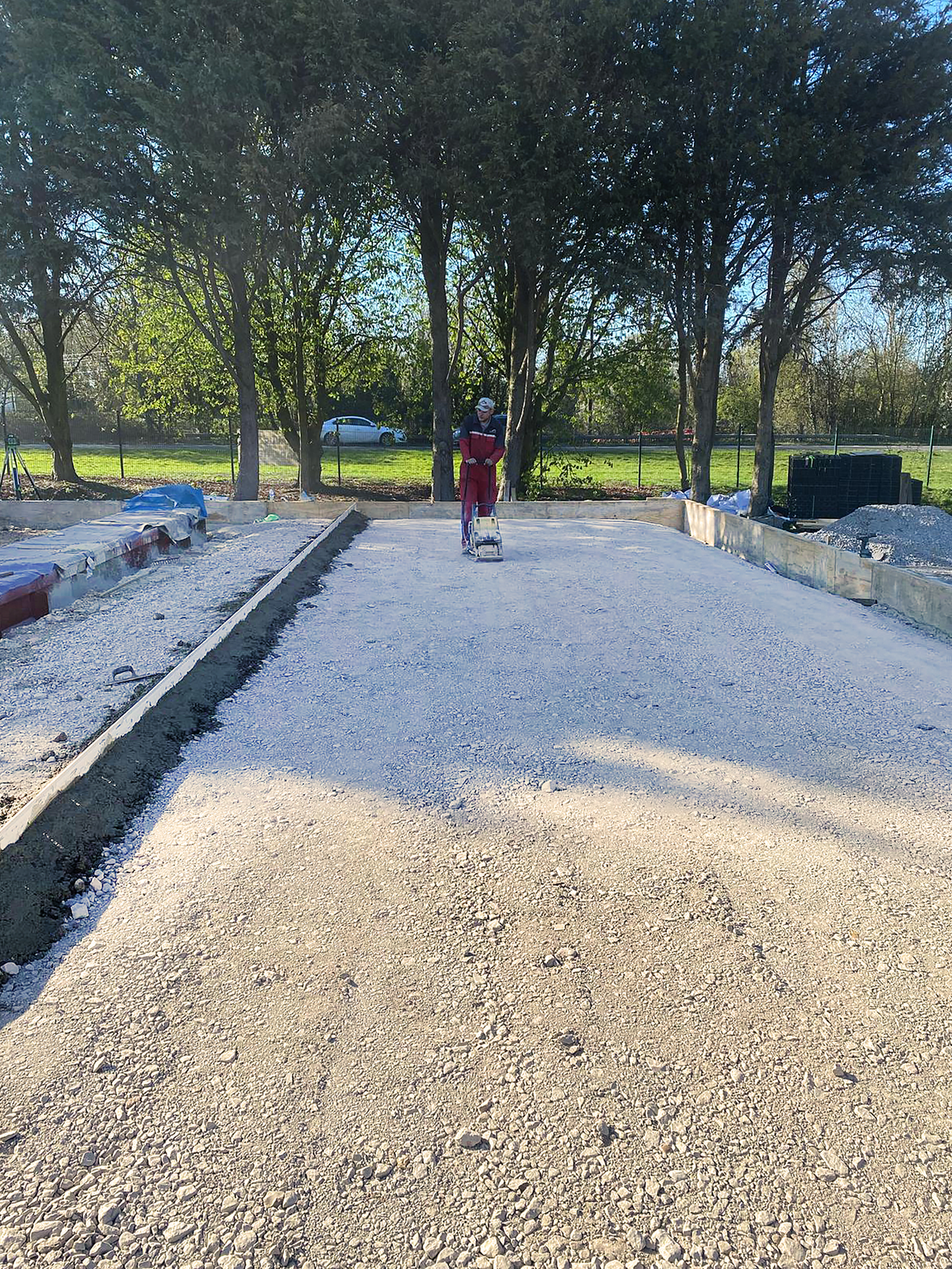

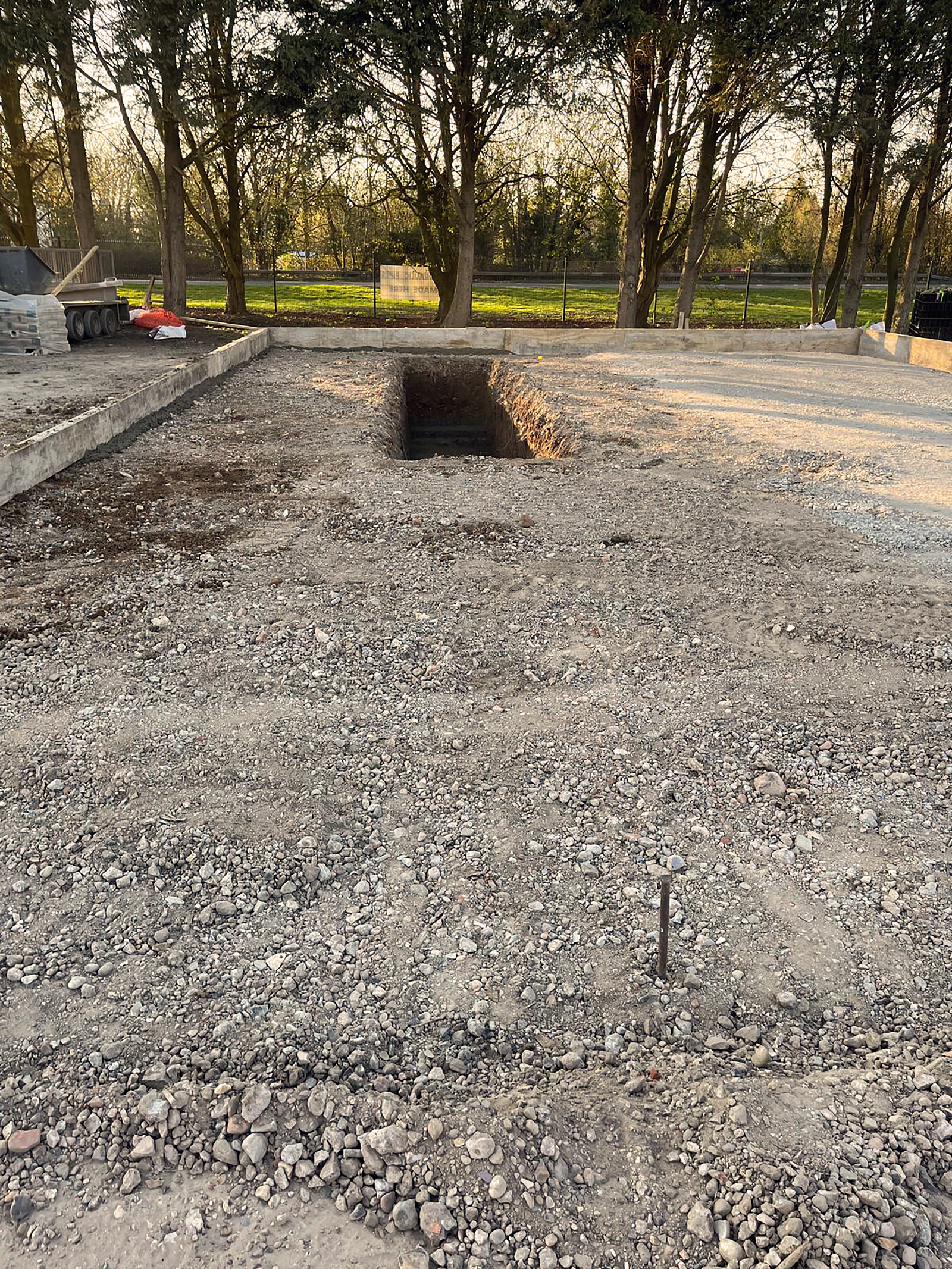

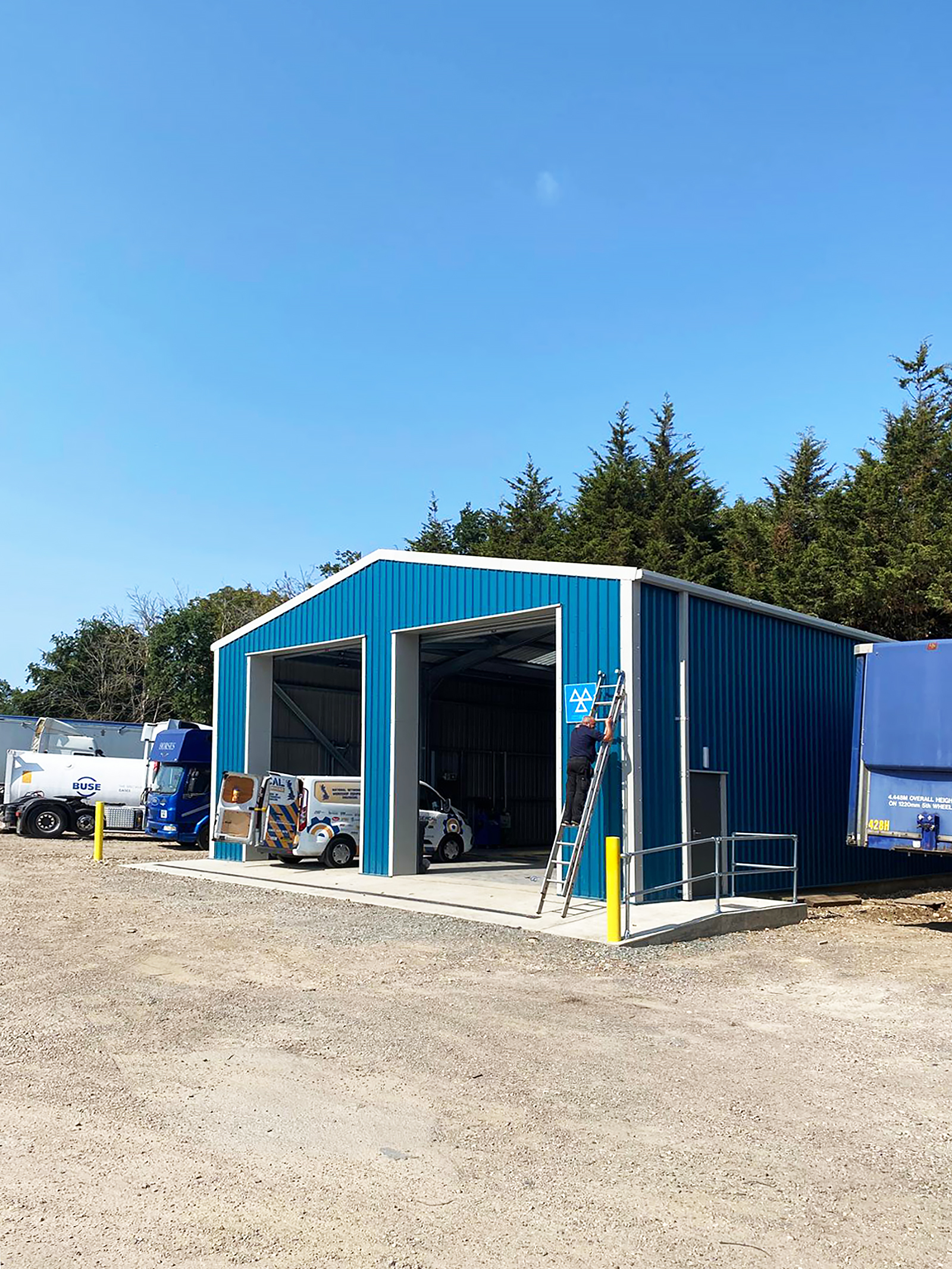

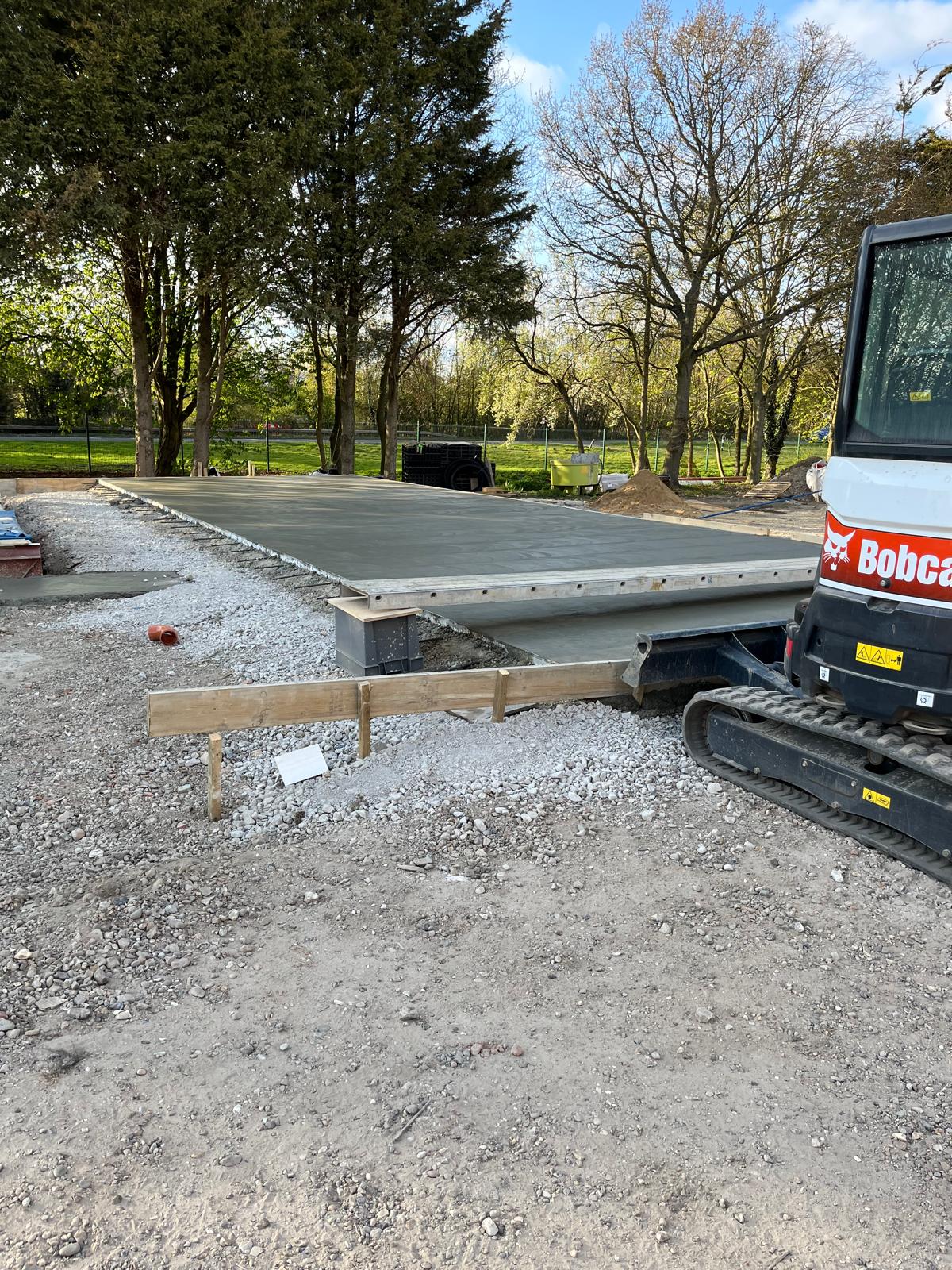

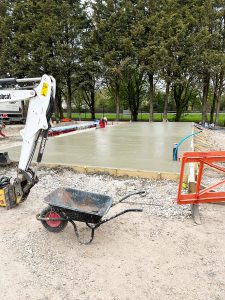

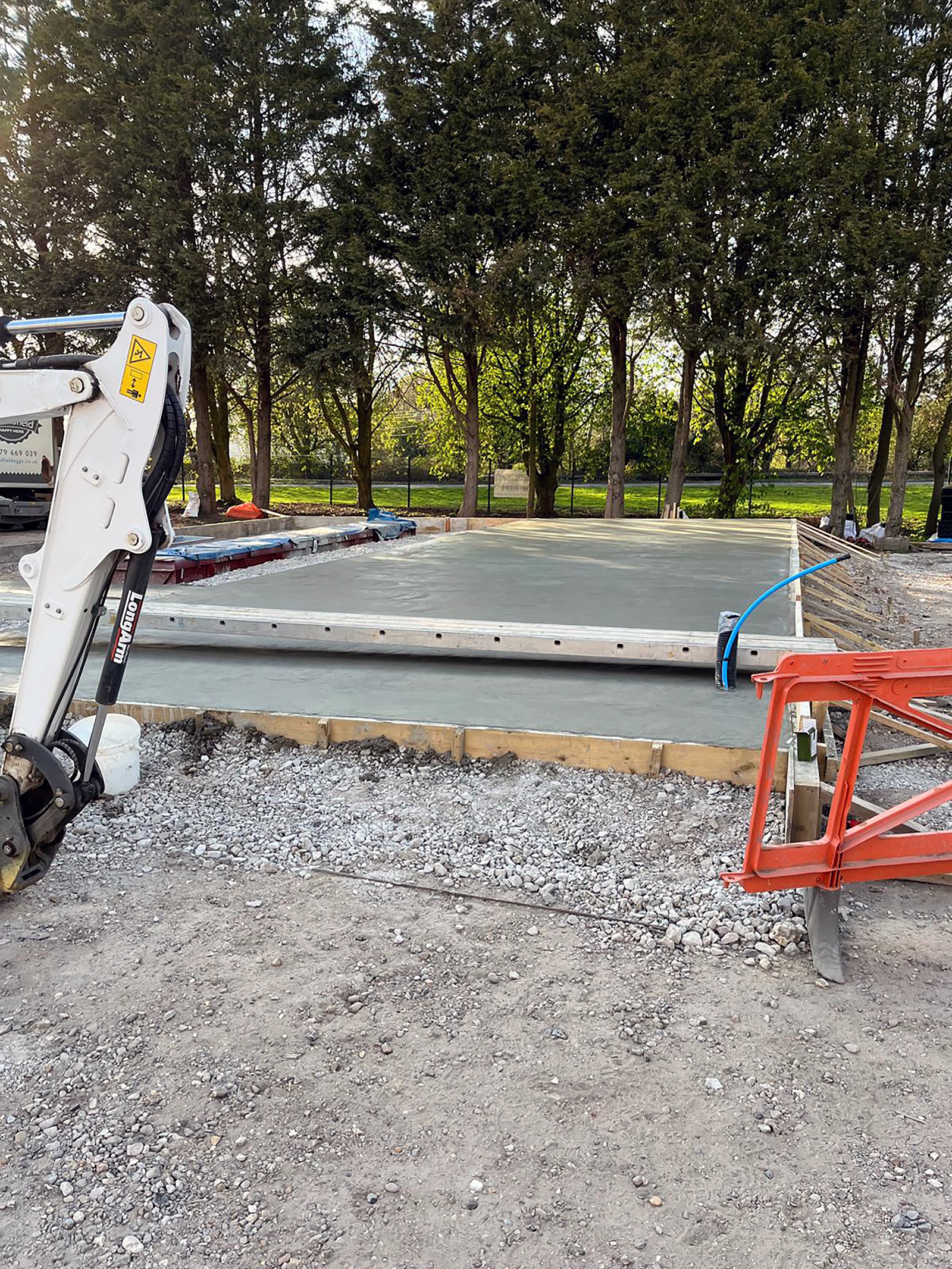

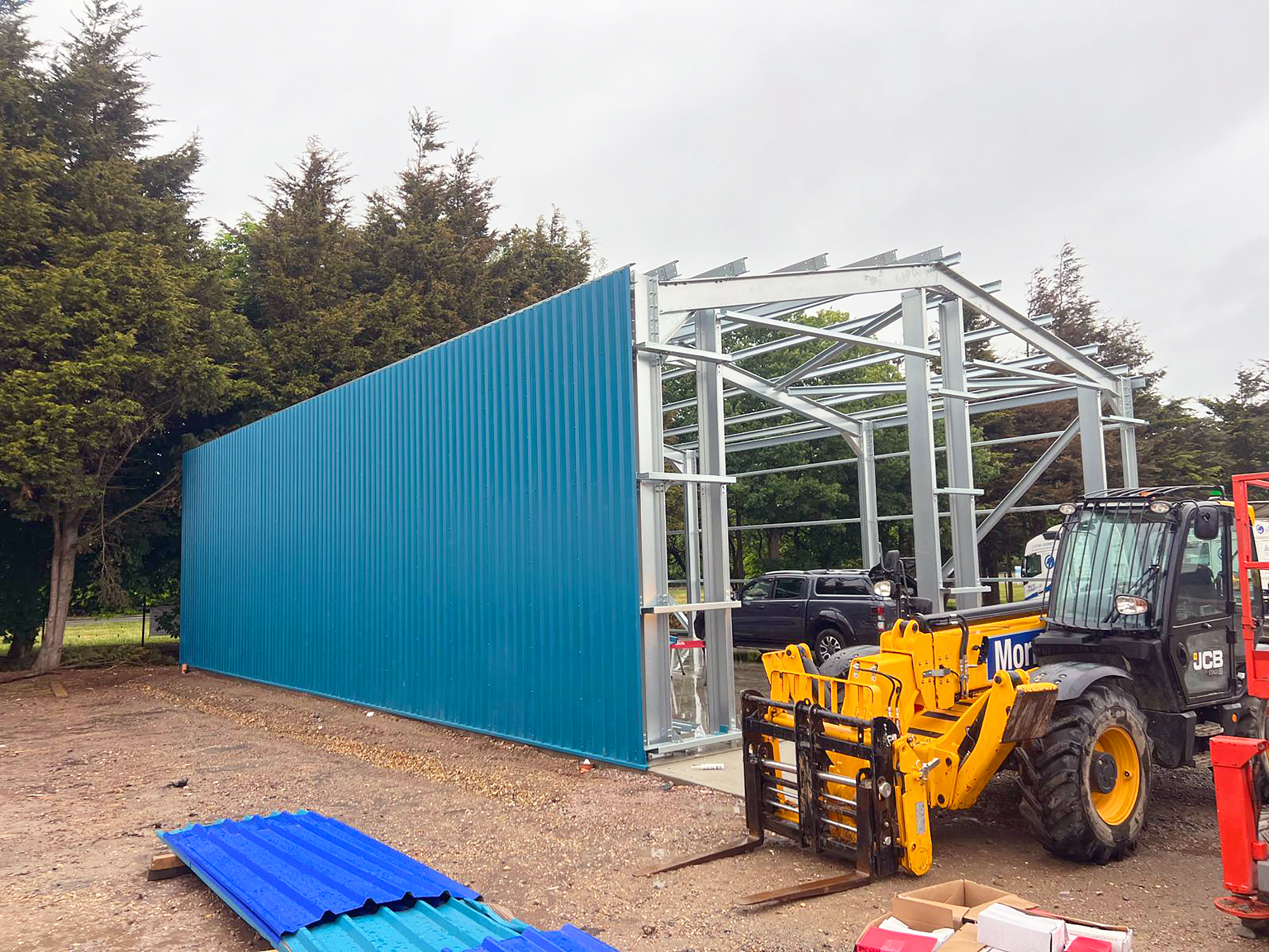

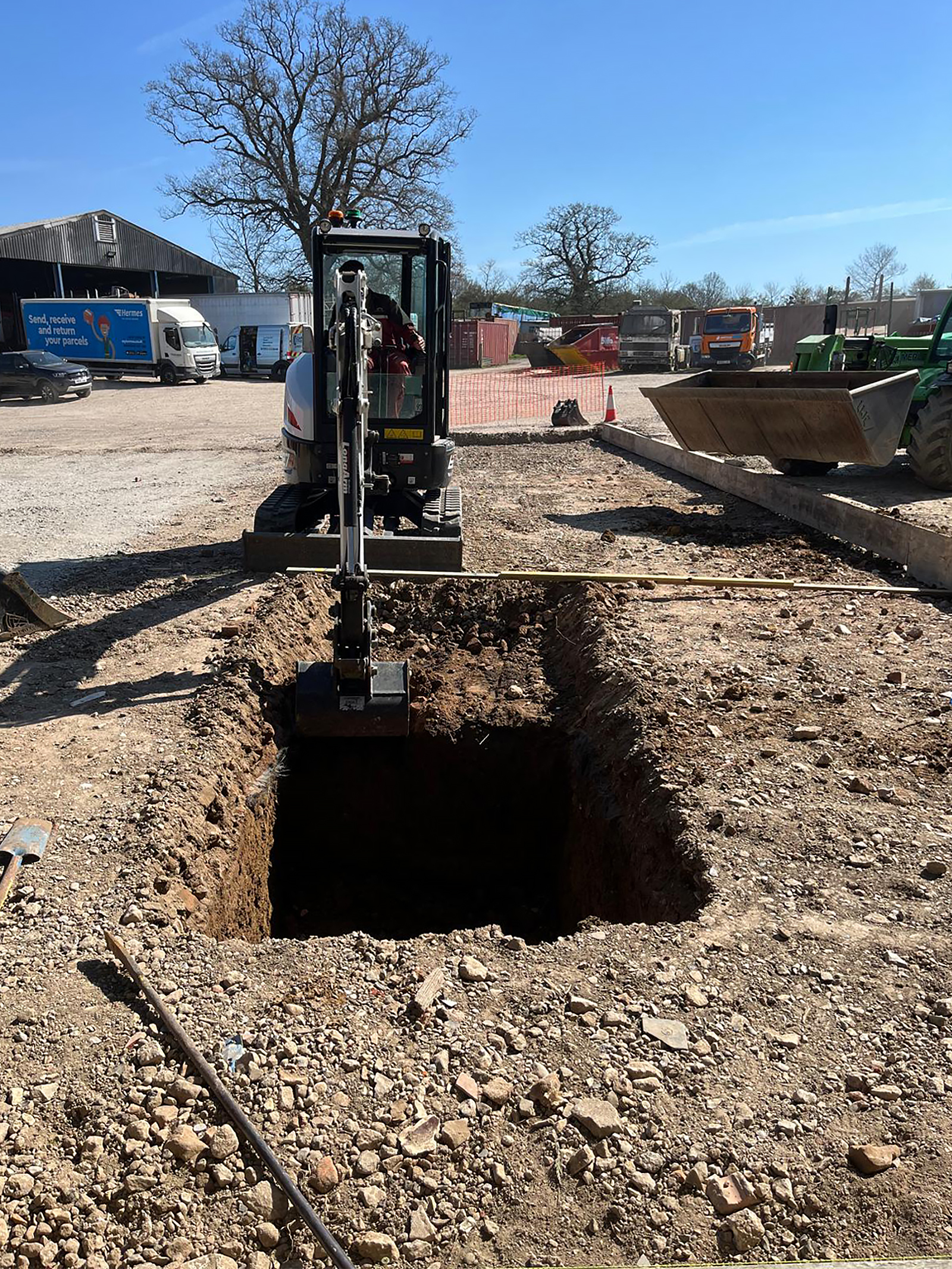

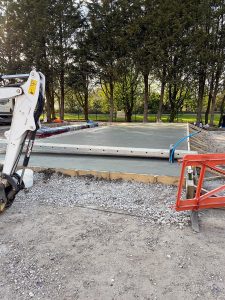

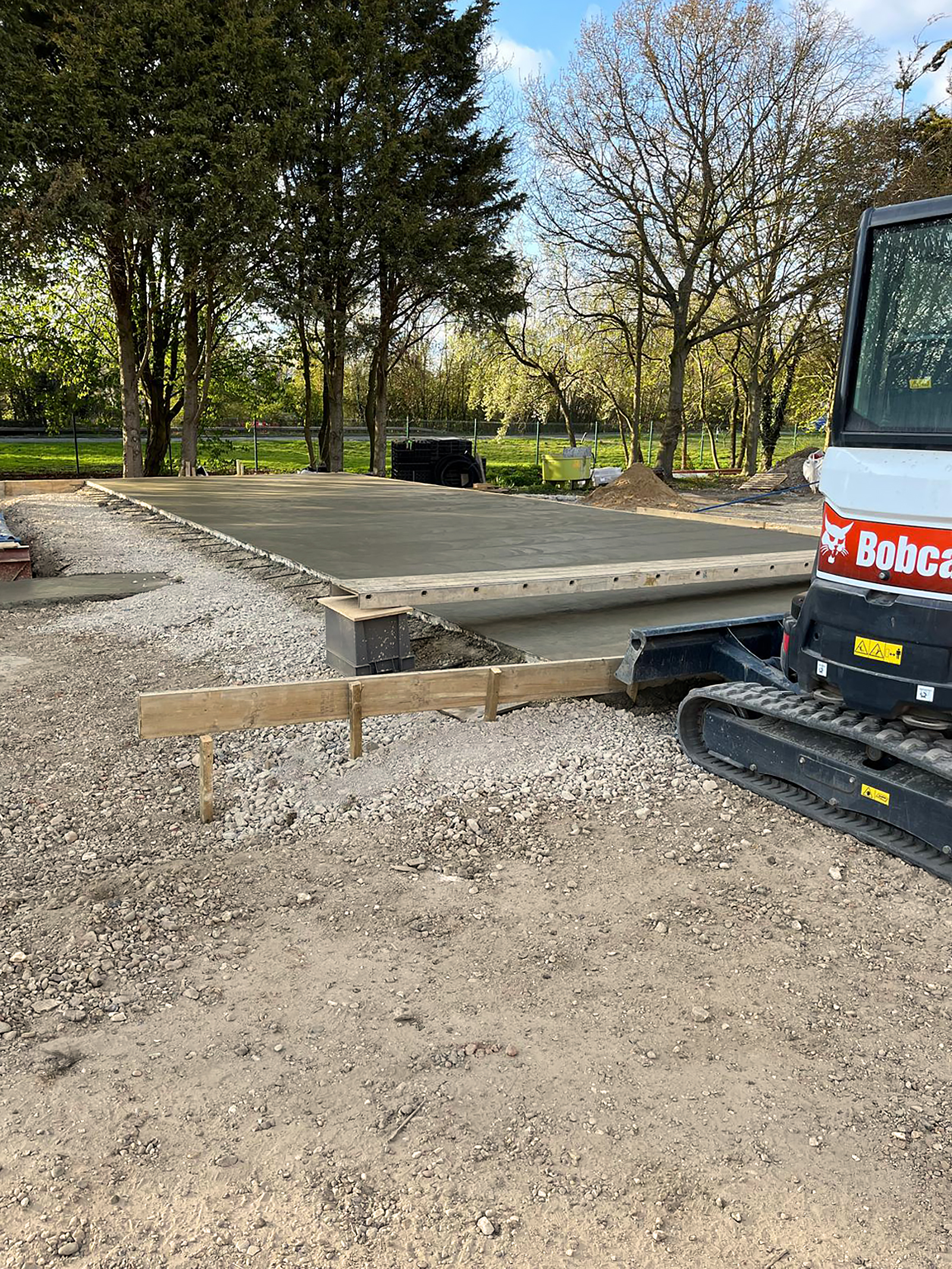

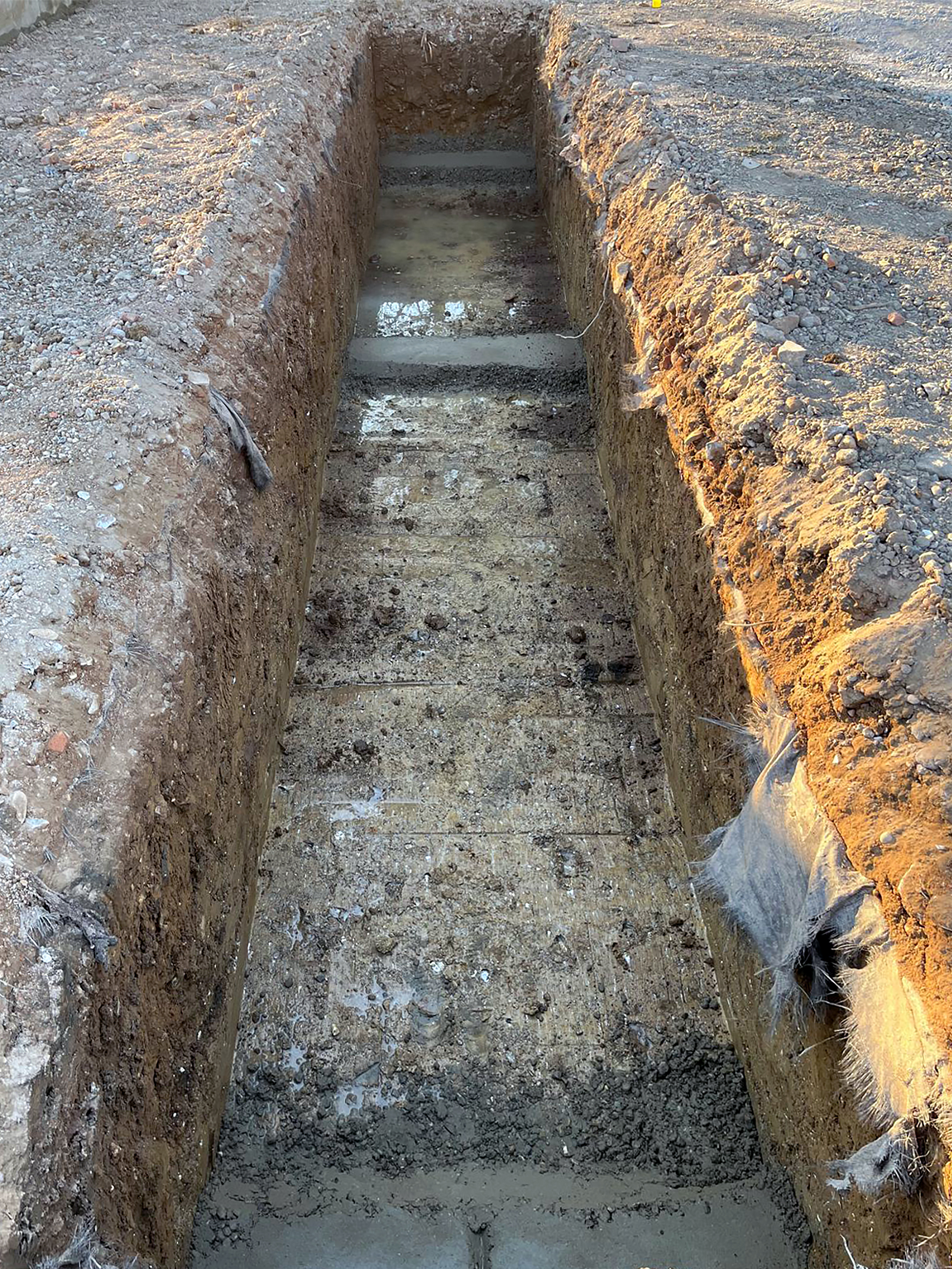

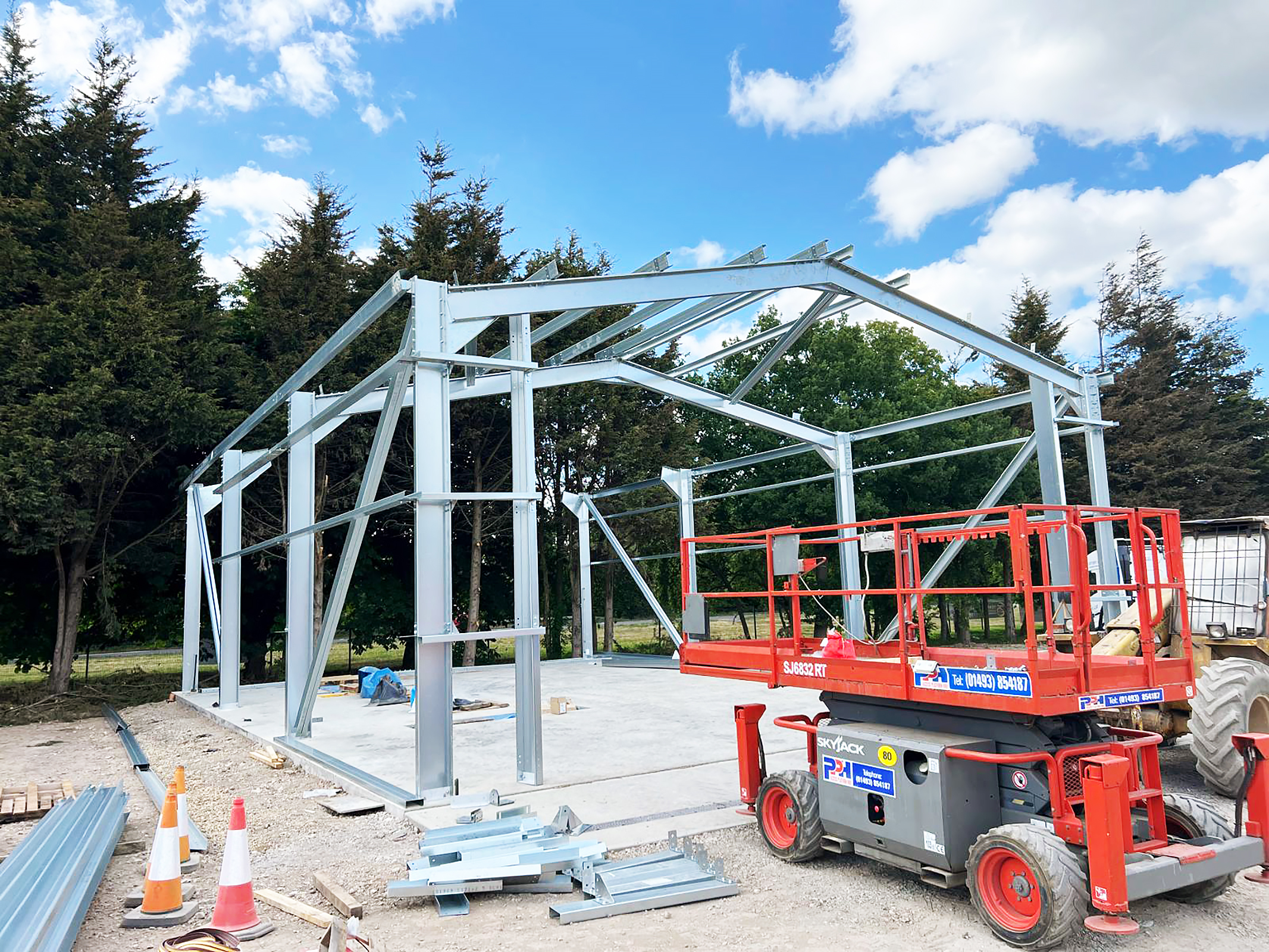

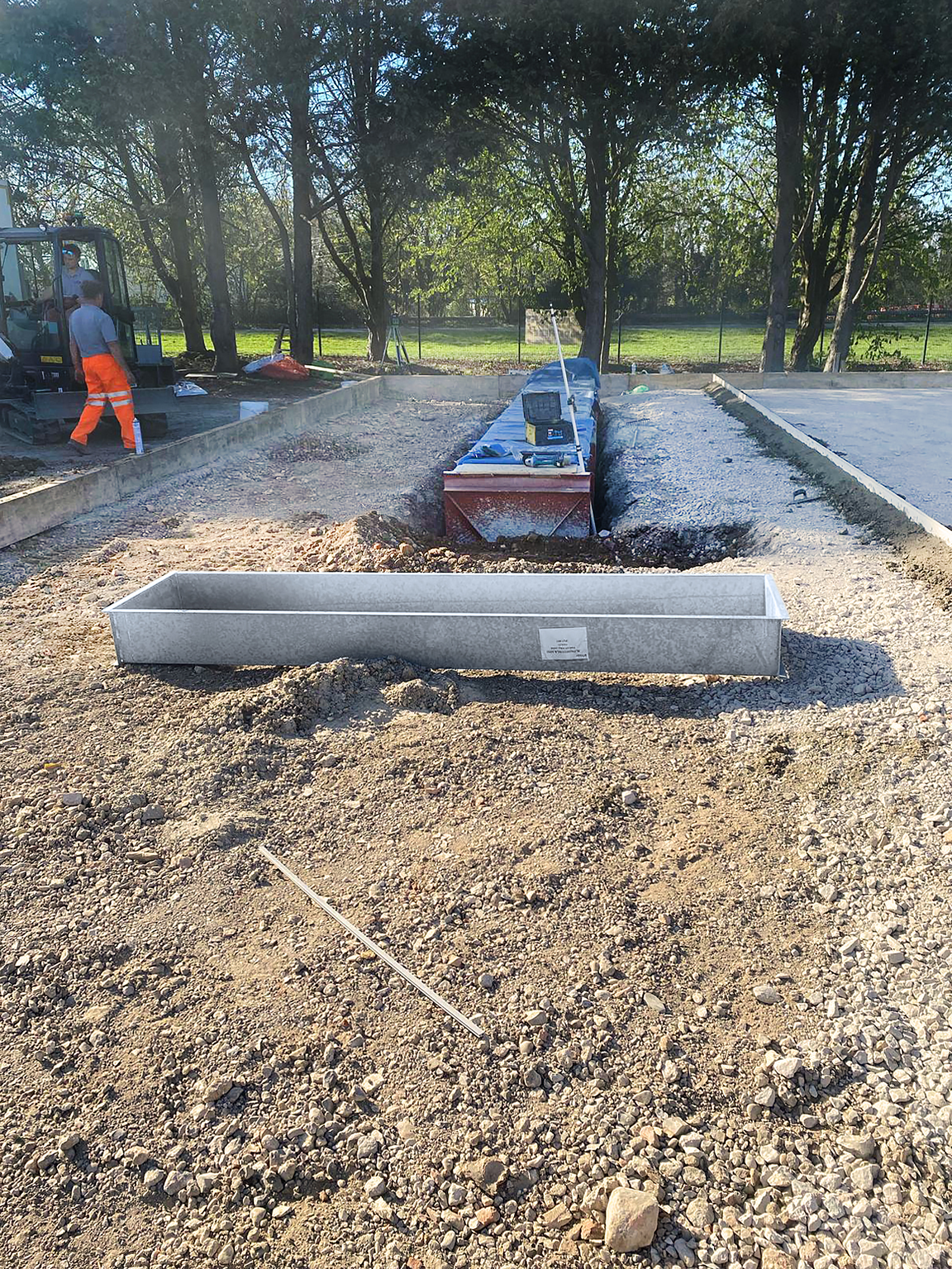

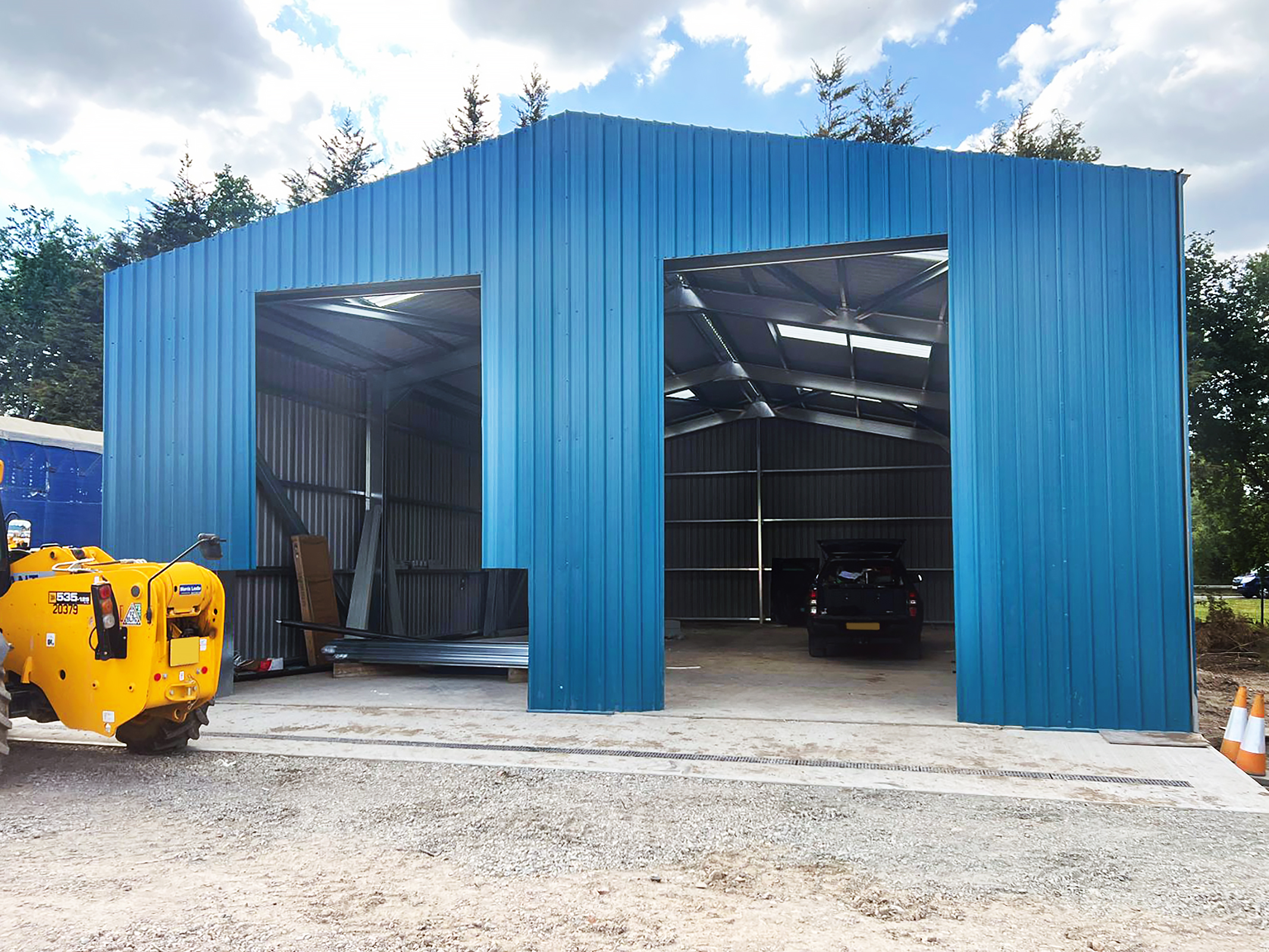

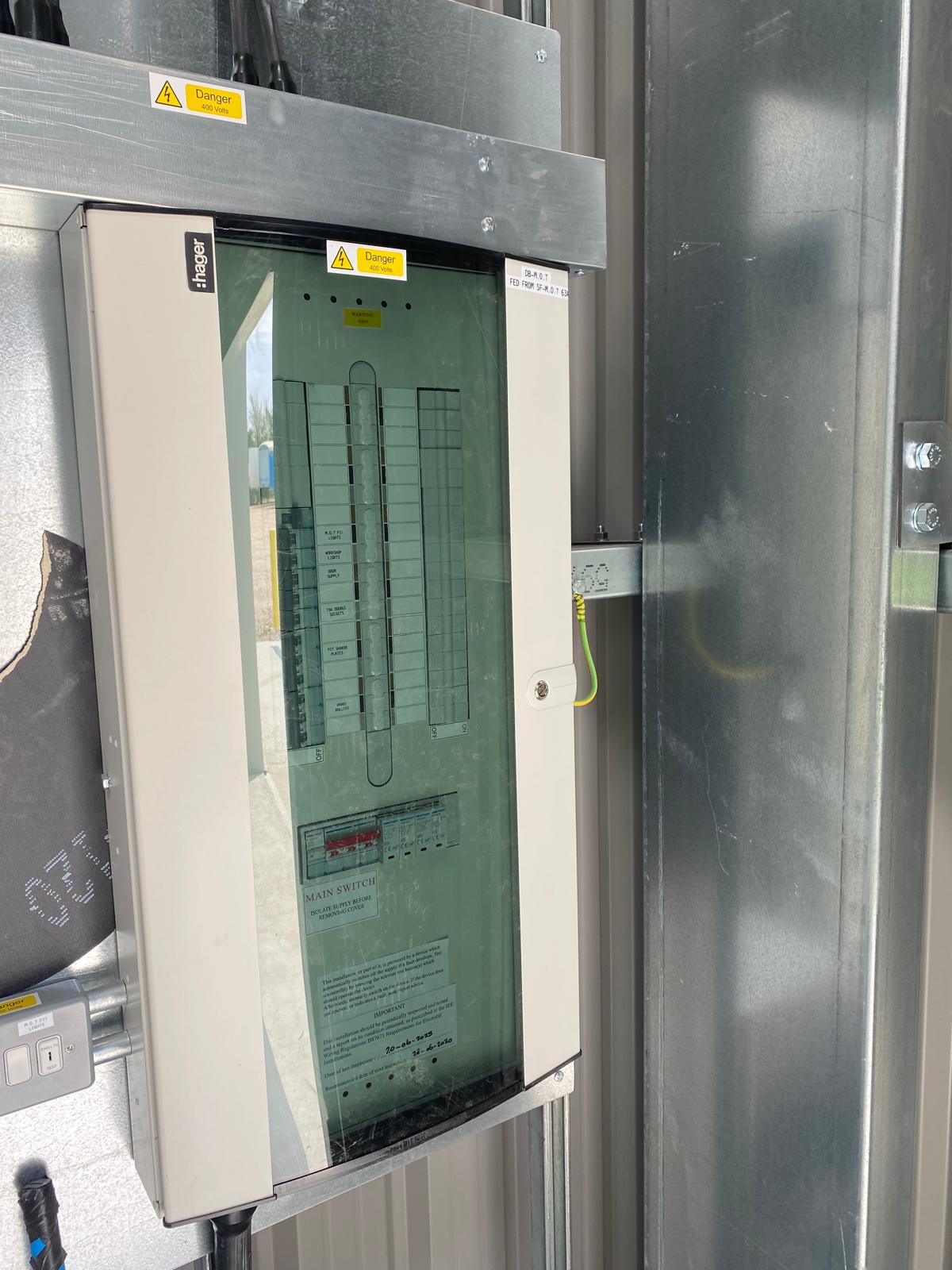

On-site, we pushed quickly from milestone to milestone. In weeks, 95% of the groundwork was completed, with slab and pit installations providing a strong foundation for what was to come. By mid-May, the building stood ready. Between April and June, we coordinated site activities, including tree clearing, cladding installation, and electrical installations. Our oversight kept teams aligned and timelines tight.

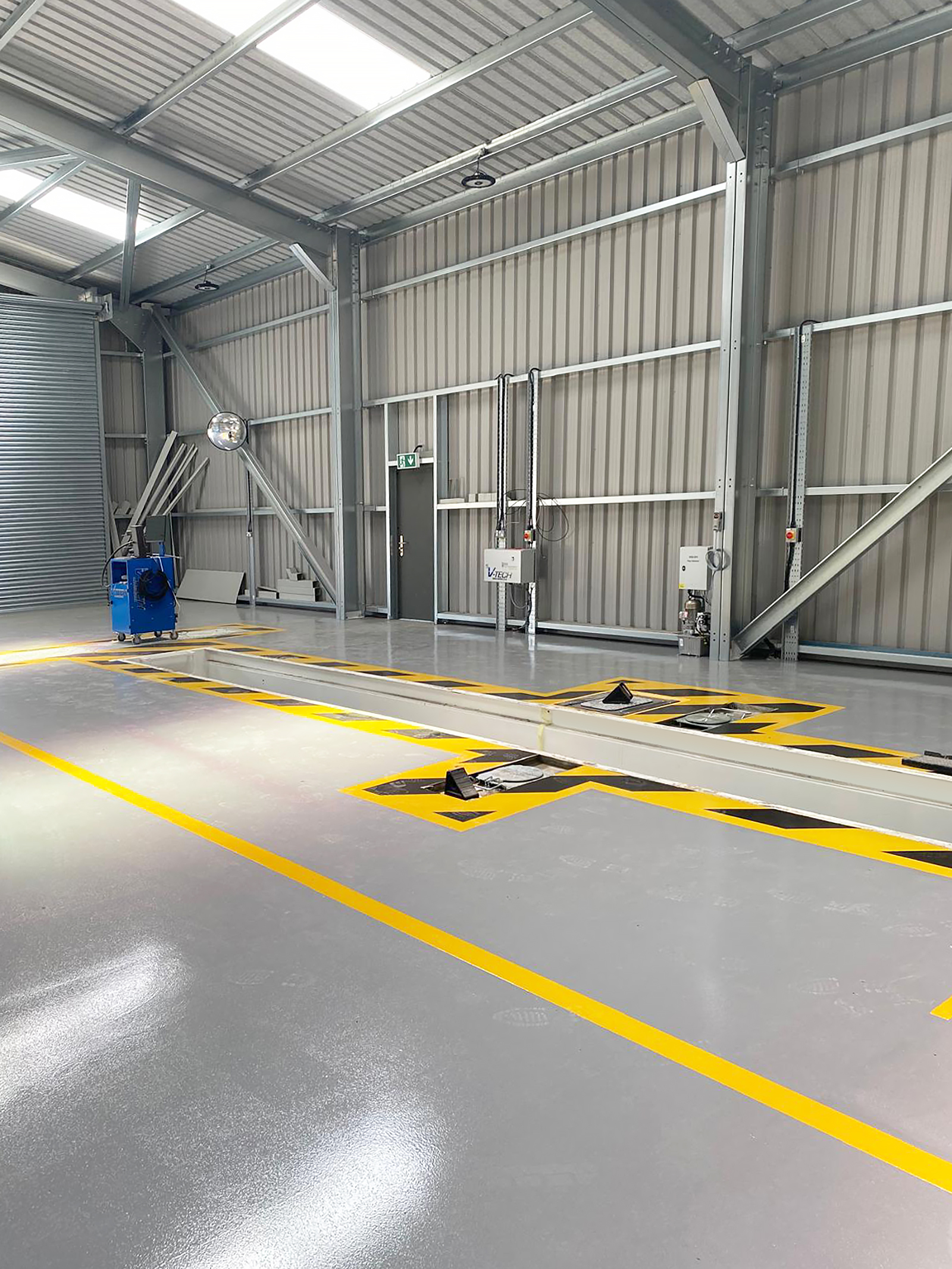

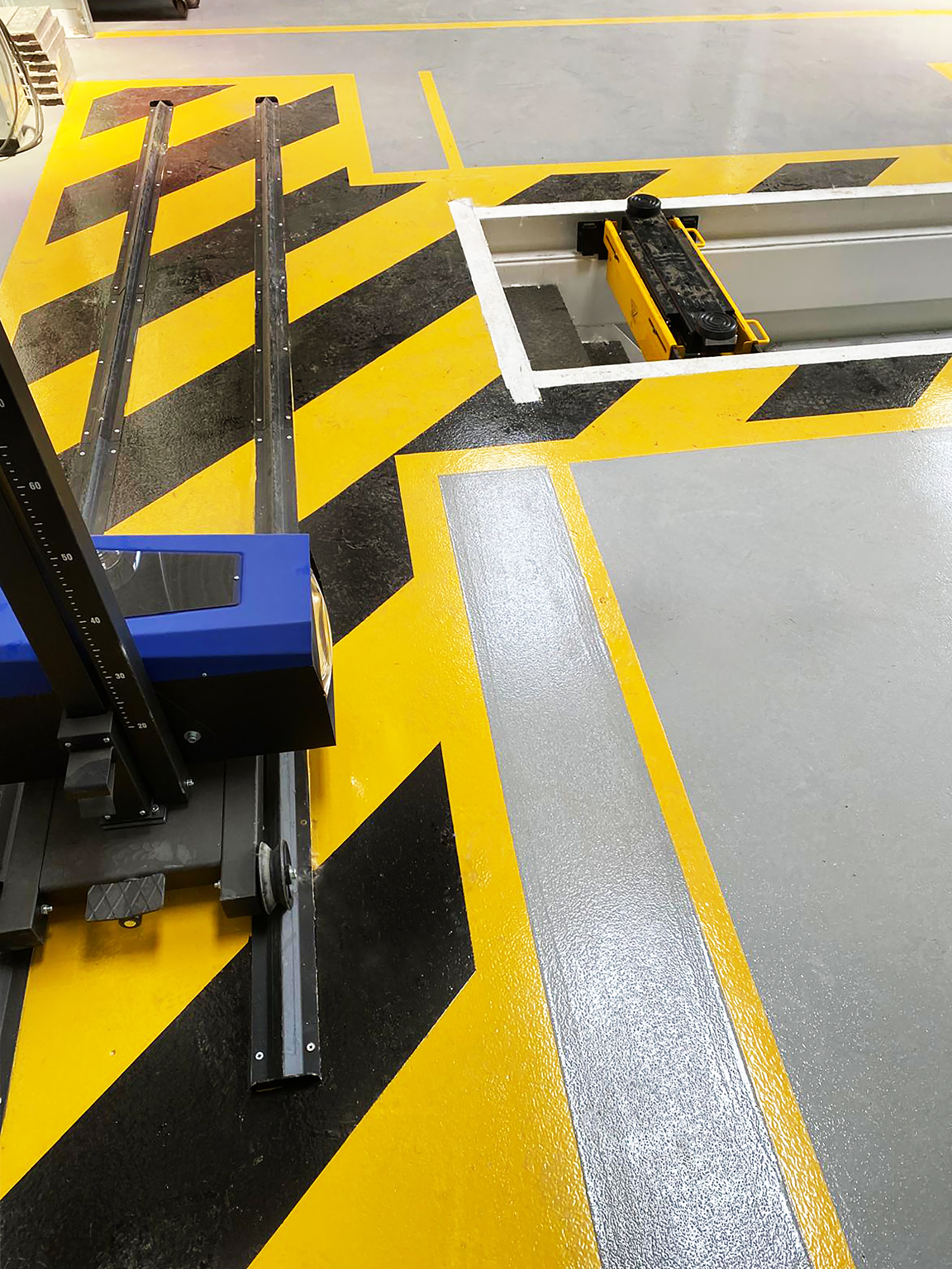

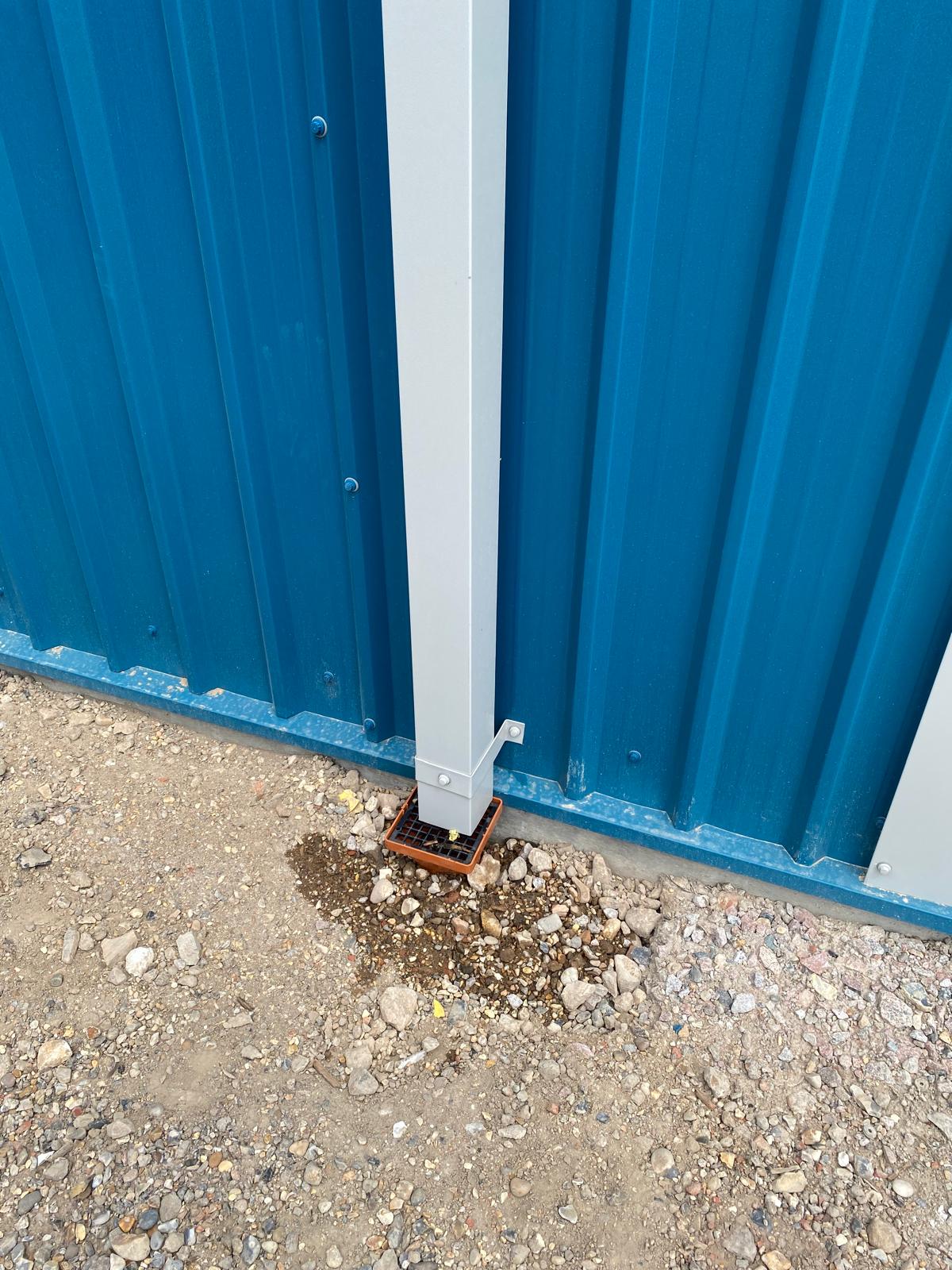

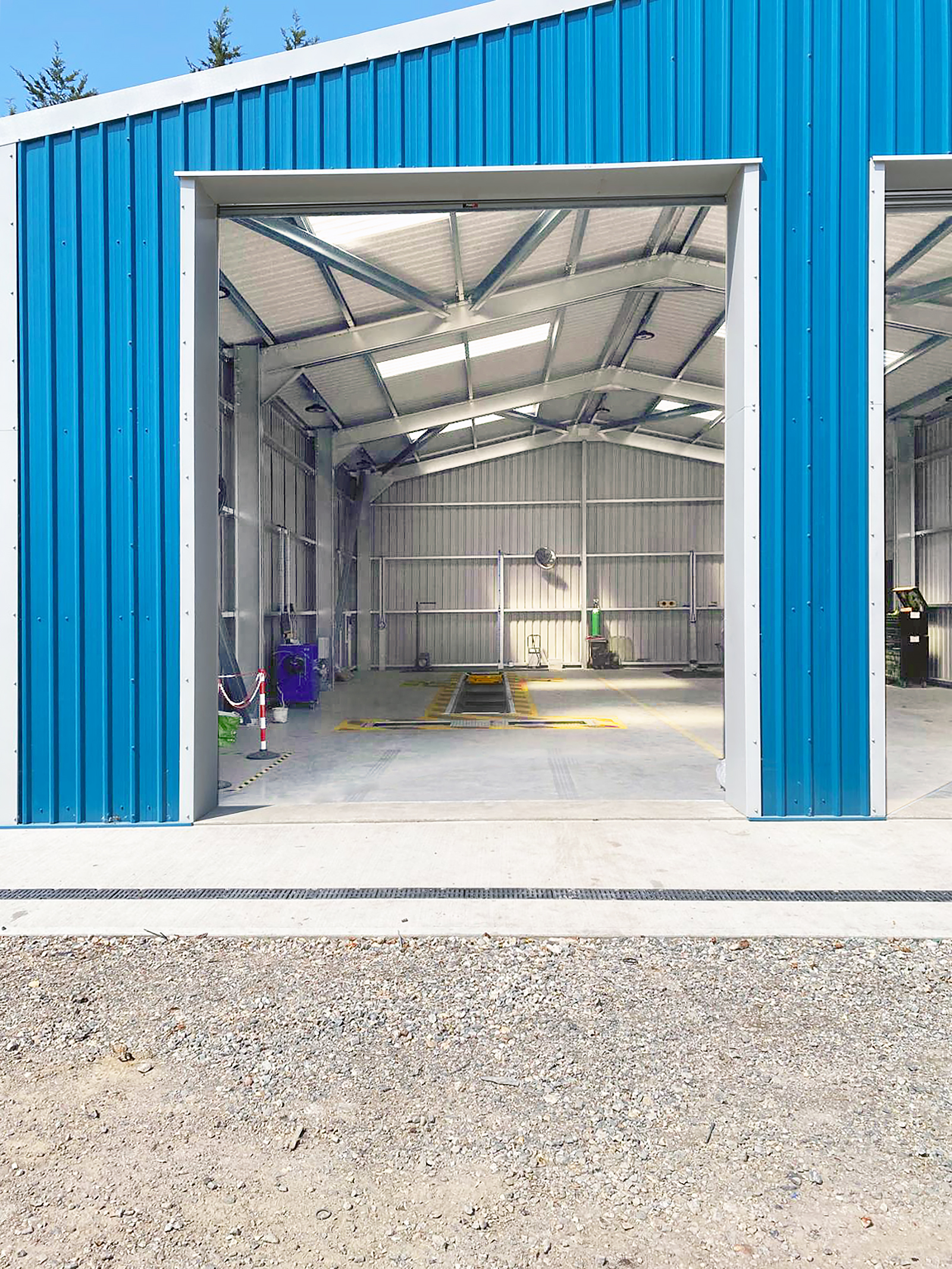

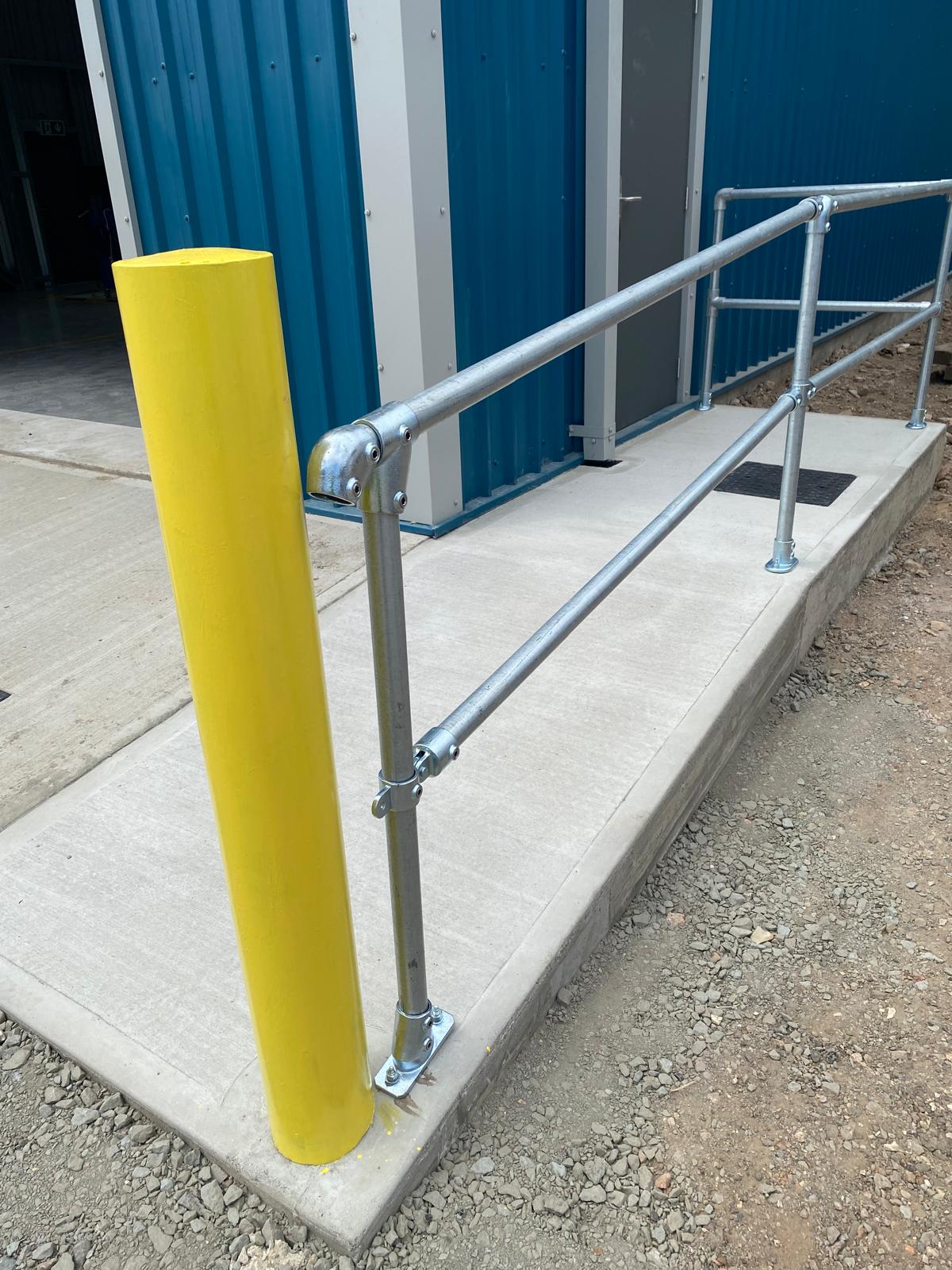

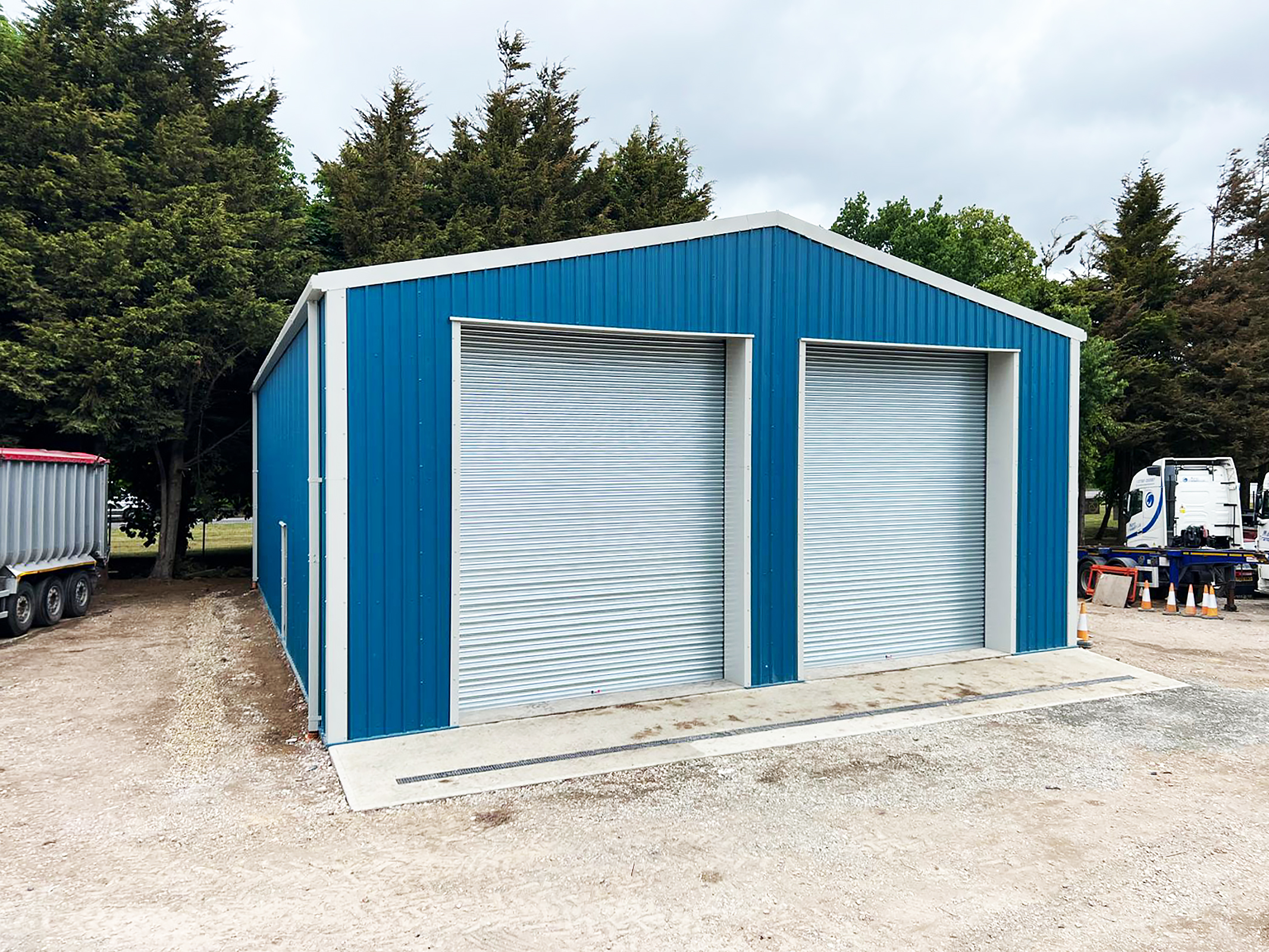

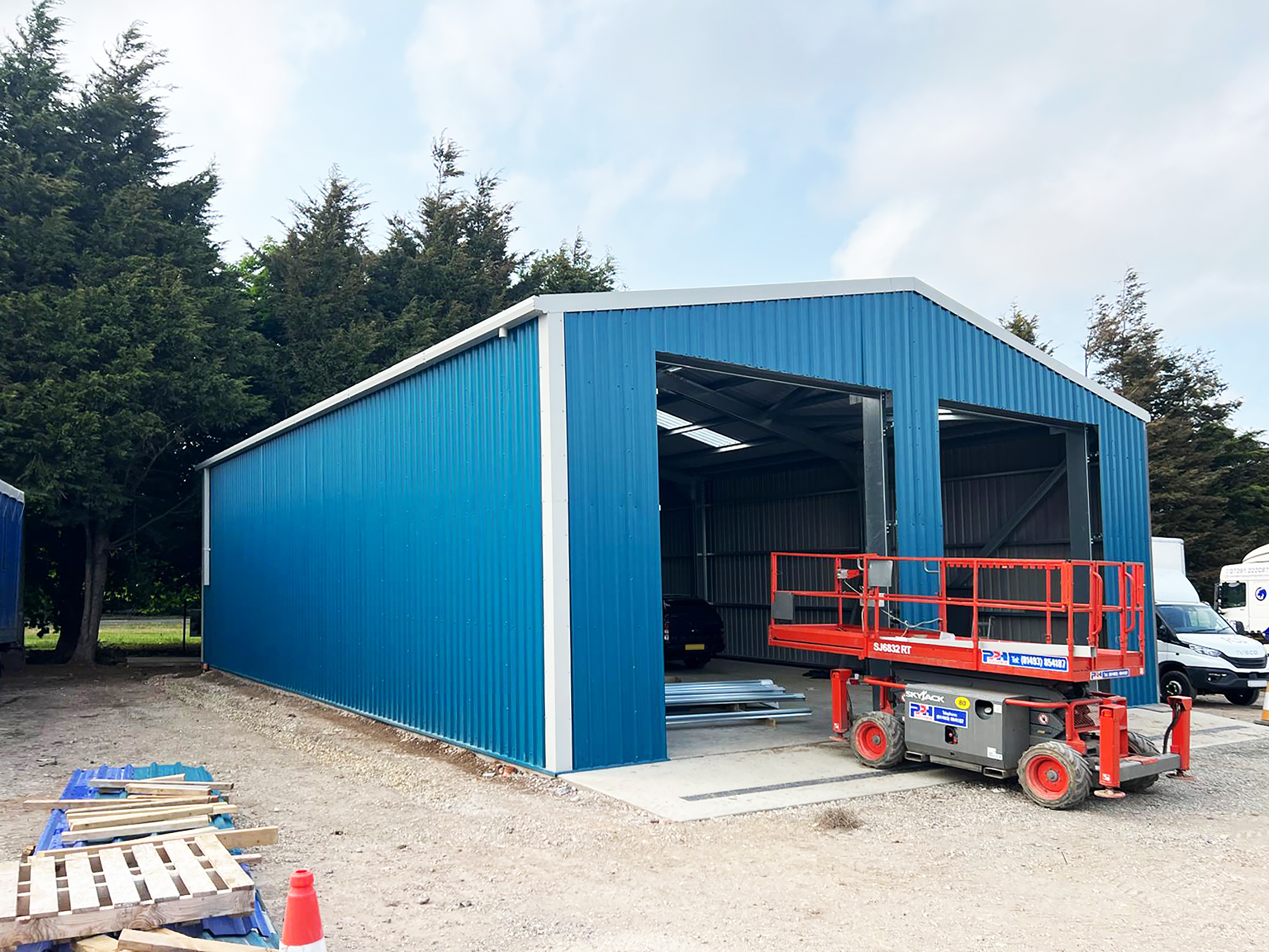

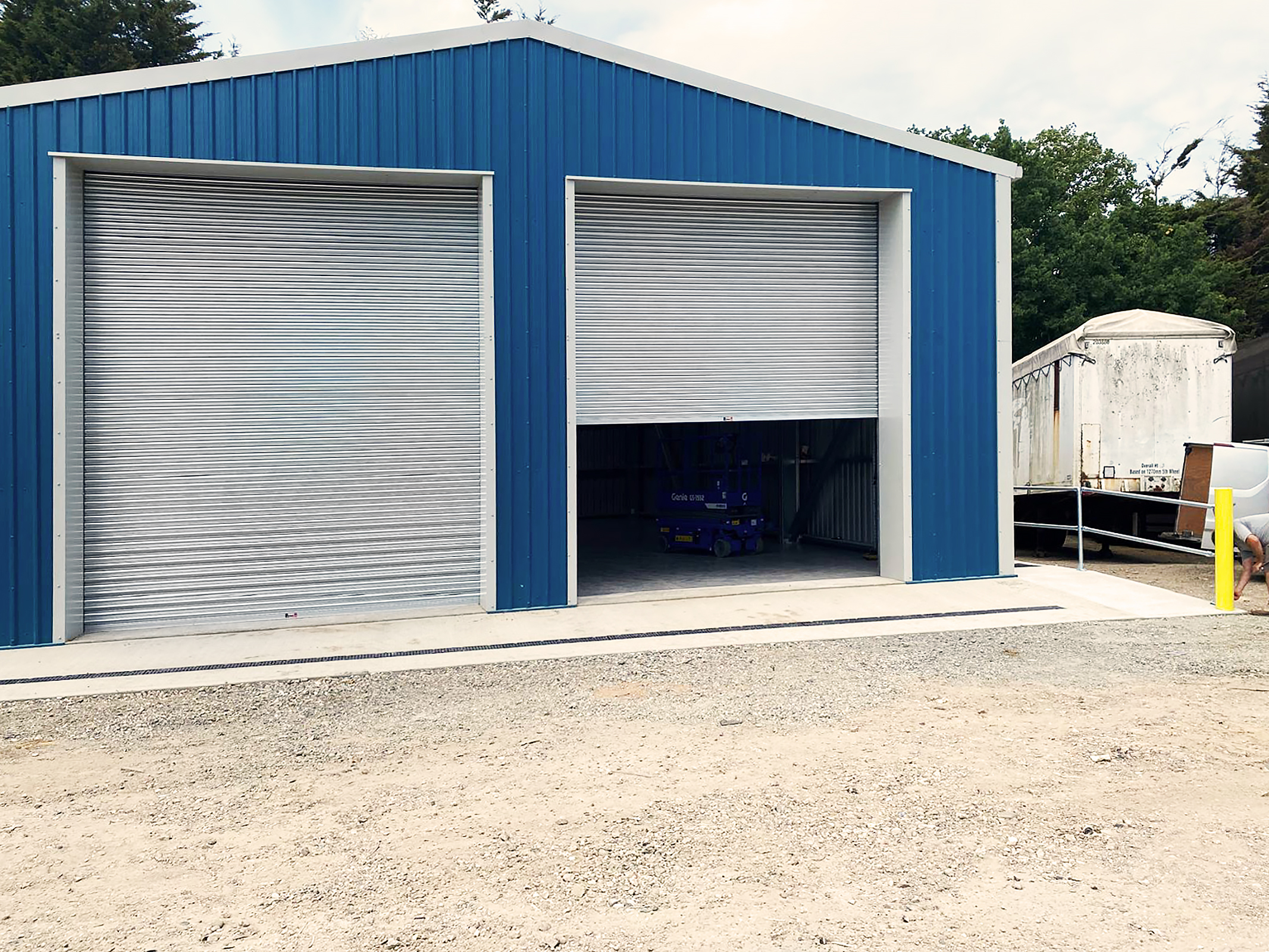

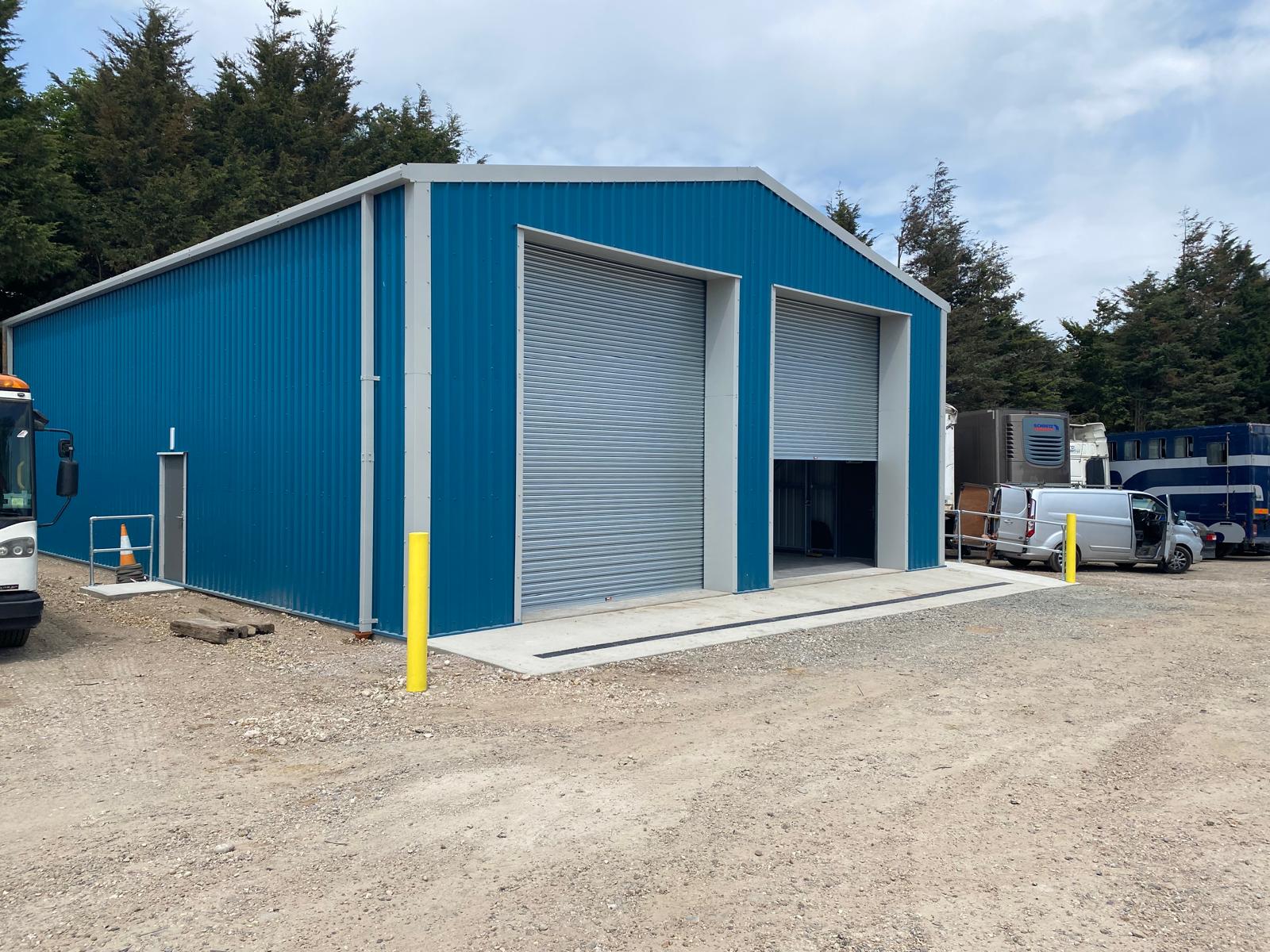

MOT equipment arrived in June. After completing equipment installation and drainage work, a durable epoxy resin floor was added to the workshop. This durable flooring, which resists oils, chemicals, and heavy use, provides a clean, professional look. The epoxy also formed demarcation lines and chevrons around the inspection pit, resulting in an attractive, hard-wearing, and safety-compliant finish. All this was completed by late June, ensuring readiness ahead of the final DVSA sign-off.

Compliance, DVSA Liaison and Final Sign-Off

With the facility physically complete, attention shifted to compliance. Throughout the project, we coordinated closely with solicitors and the DVSA to address lease arrangements and prepare the VT01 application. An Application in Principle (AIP) had already been obtained, enabling the installation of the testing equipment and facilitating the planned MOT training and equipment calibration for August.

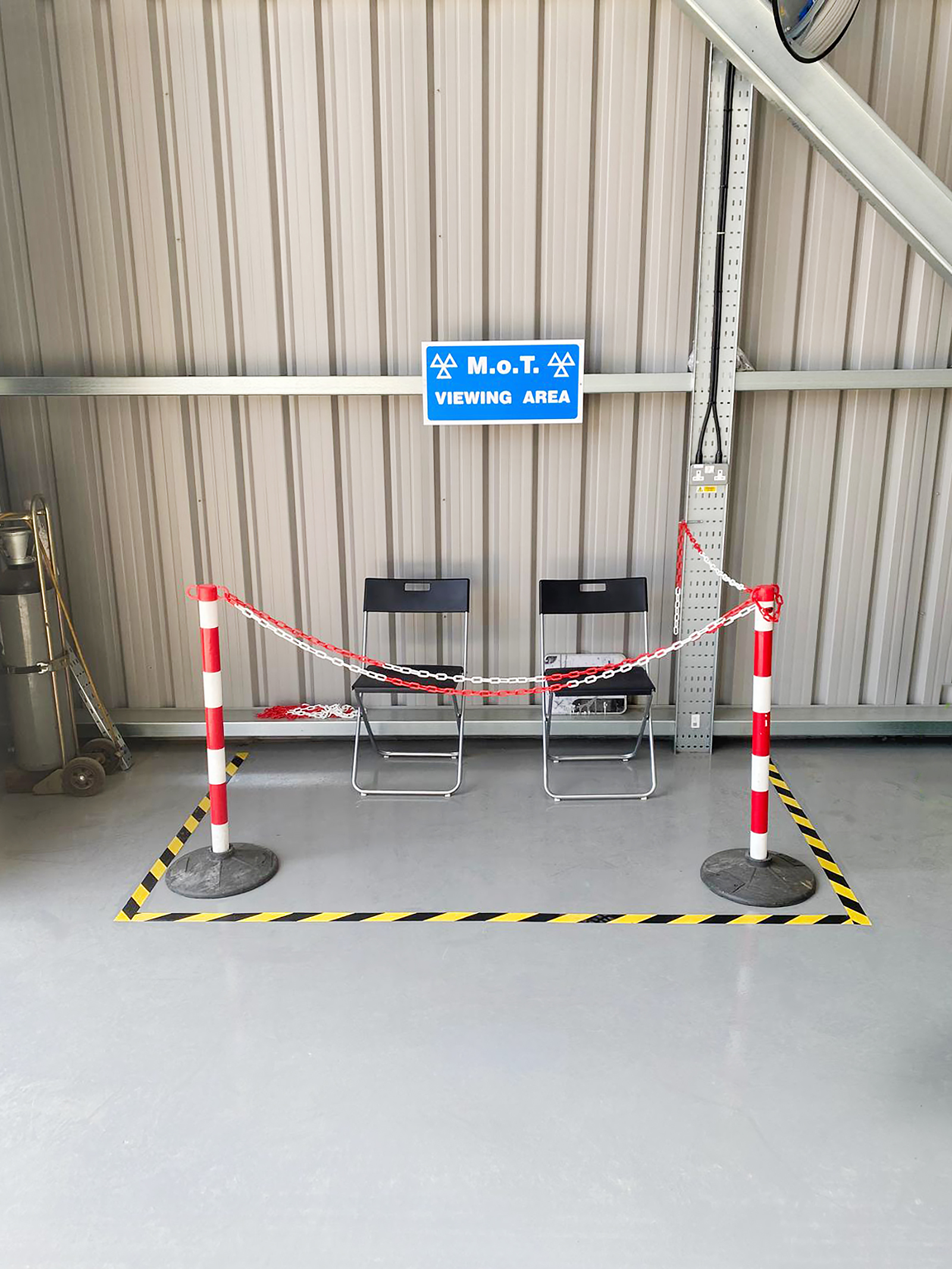

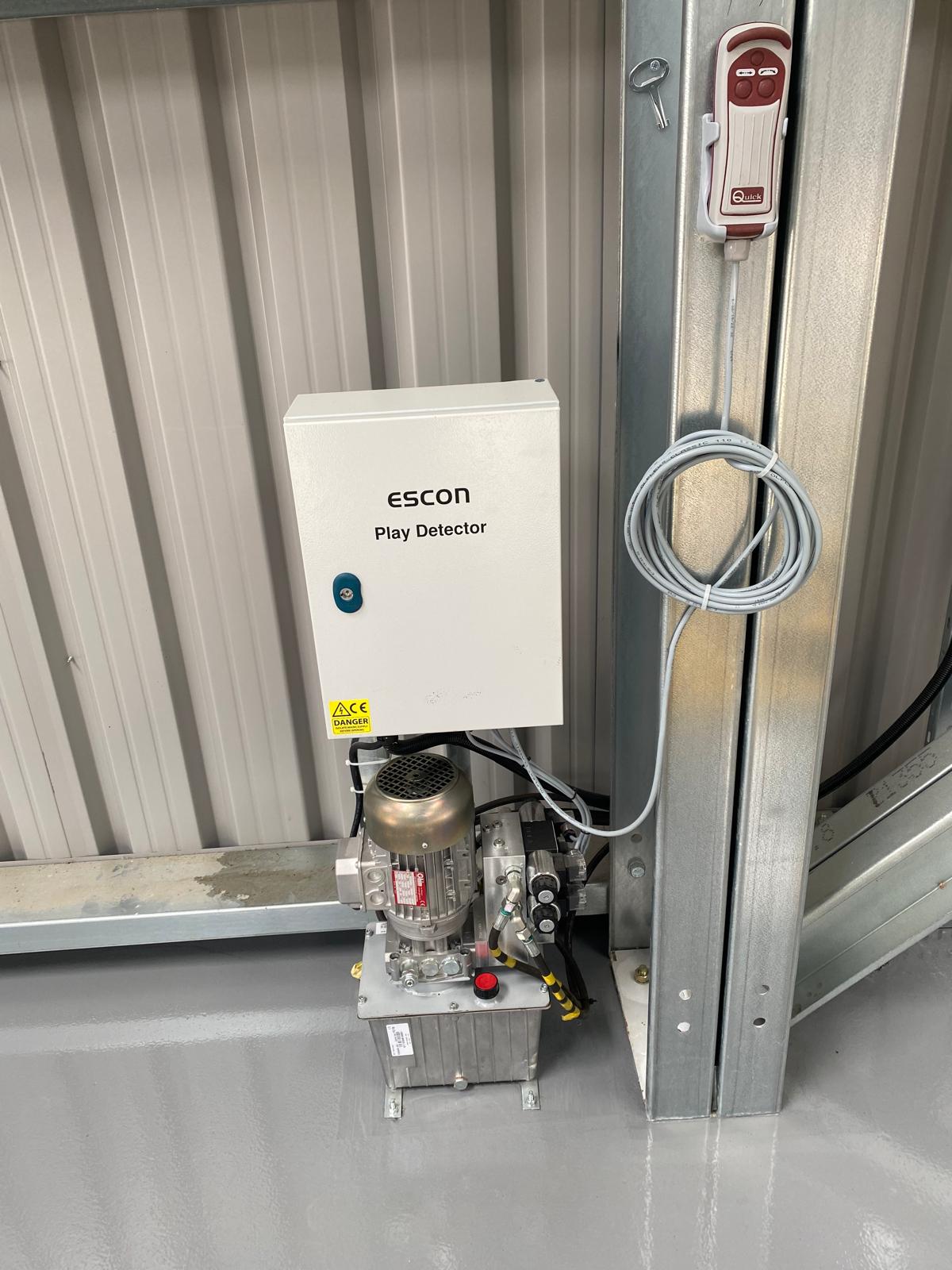

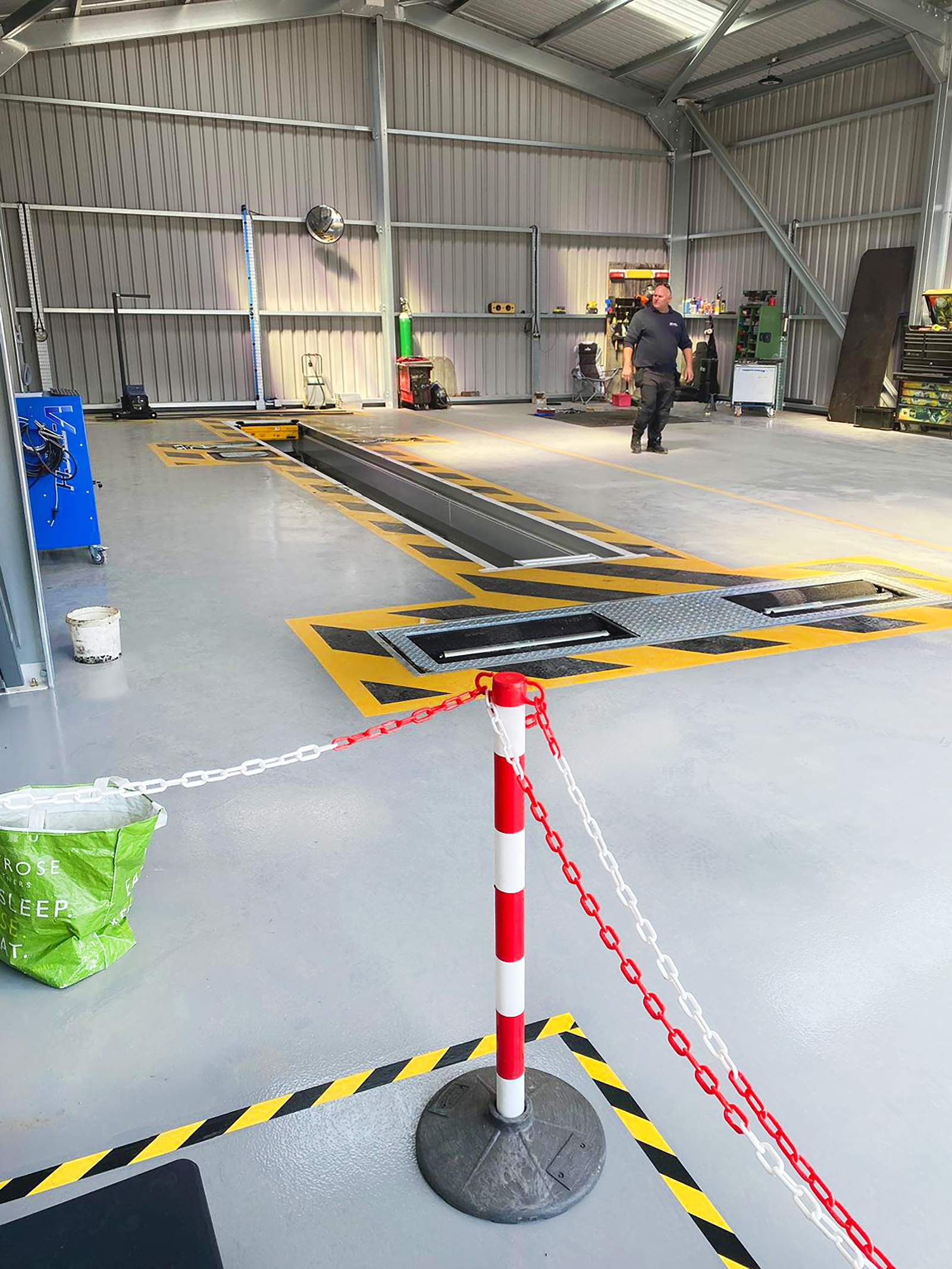

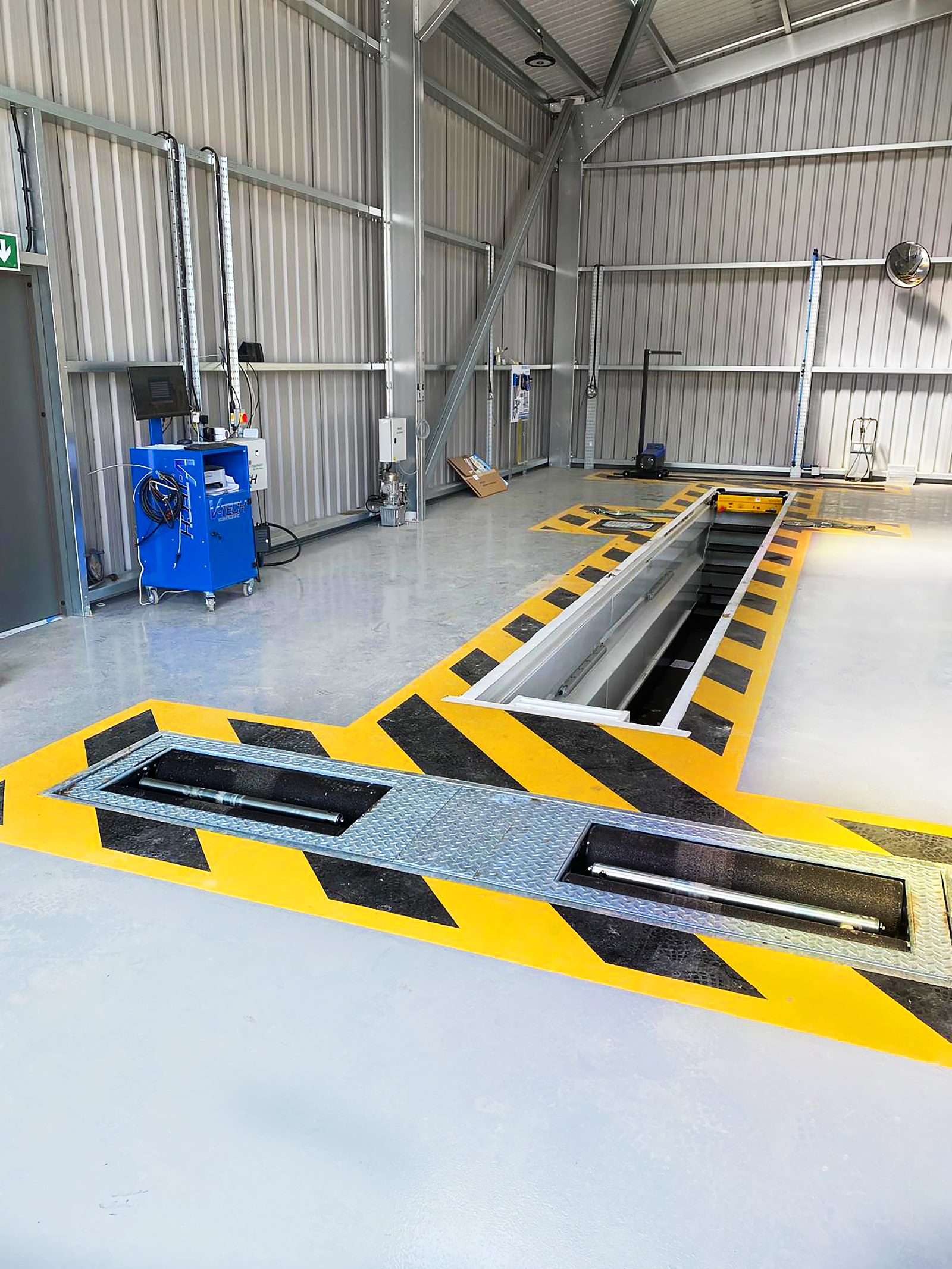

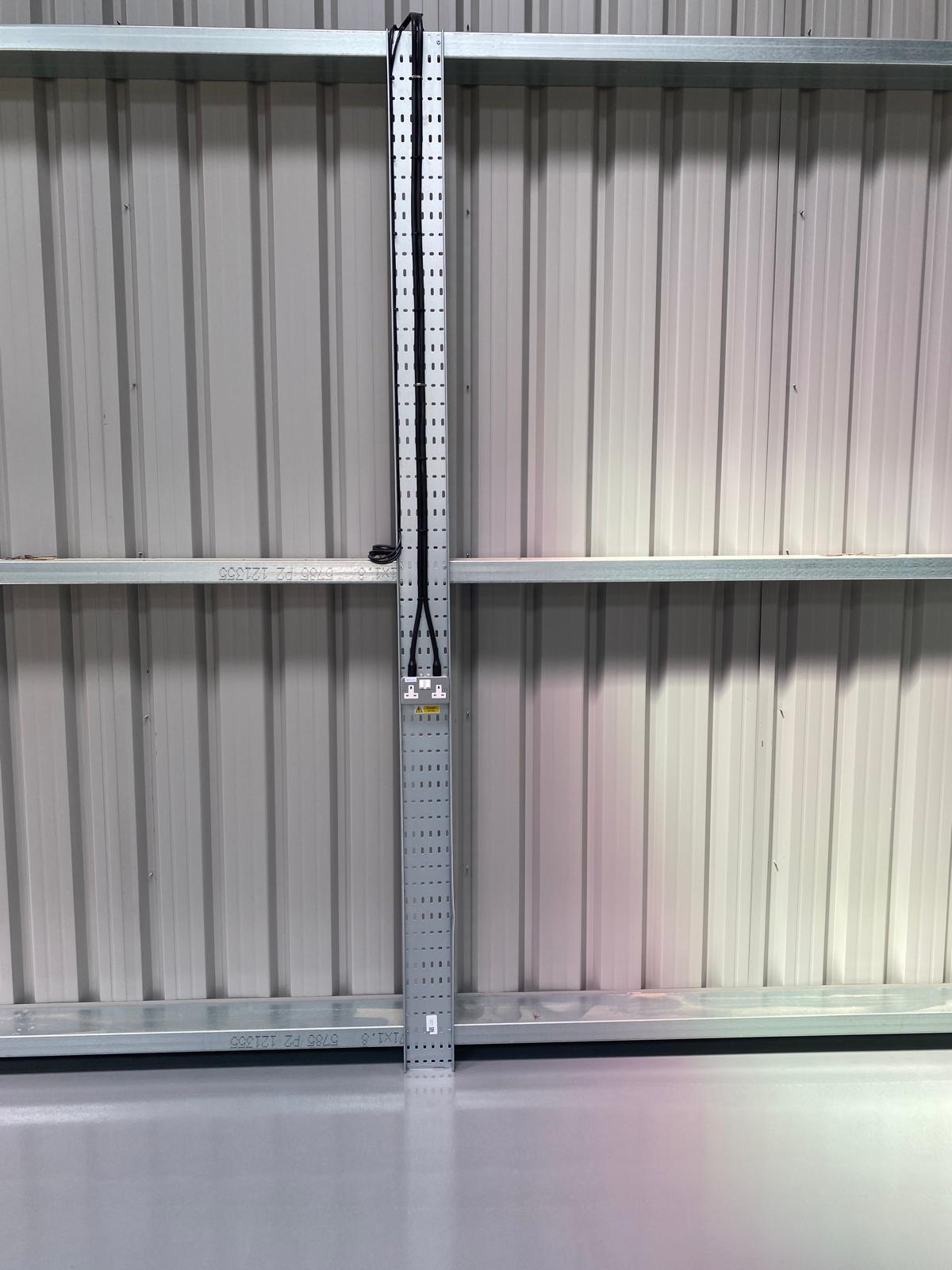

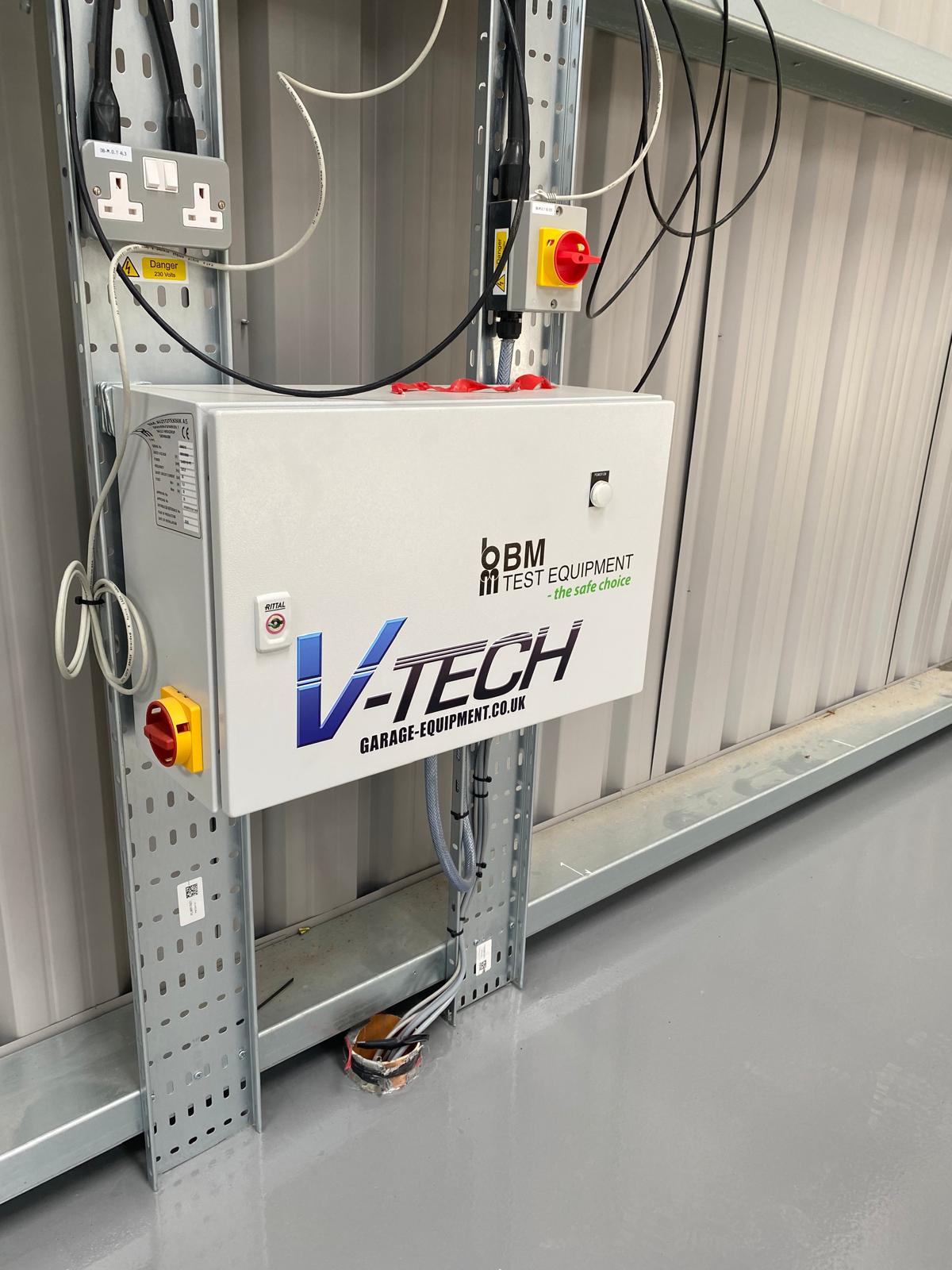

We prepared and delivered all required DVSA “Part D” documentation, ensuring a seamless, compliant application. The DVSA signed off the bay, which was equipped with all the essential MOT tools: the pit, an MTS Connected Brake Tester, an MTS Connected Gas Analyser and Smoke Meter, a Headlamp Aligner, a Jacking Beam, and a full Ancillary Pack. Everything was set up to ensure testing of Class 7 vehicles was smooth, compliant, and efficient.

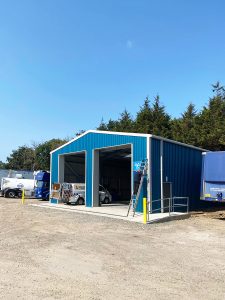

Delivering Confidence and Results

Thanks to expert project management and hands-on support from NextGen Workshops Projects, AL Engineering now has a superb Class 7 MOT testing facility without the stress often associated with complex construction projects.

From overcoming early planning hurdles to coordinating delivery and ensuring compliance, the value of our structured project oversight was clear: the project stayed on track, risks were mitigated, and AL Engineering remained confident in running their business.

With Nextgen Workshops Projects from V-Tech, you’re not just buying equipment. You’re working with a team that manages the whole process, so you can focus on running your business.

Ready to start your MOT journey with the best of the best? Call us today on 0208 498 1288 or email sales@v-techuk.com, and one of our project managers will be in touch to get you started.
